Appendix L
Summaries of Environmental Complaint, Warning, Summon and Notification of Successful Prosecution
Reporting
Month: May 2018
Contract
No. KLN/2016/09
Log
Ref. |
Location |
Received
Date |
Details
of Complaint/Warning/Summon and Prosecution |
Investigation/Mitigation
Action |
Status |
N/A |
N/A |
N/A |
N/A |
N/A |
N/A |
Works
Contract within KTD
KDO, CEDD
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
KL/2011/01 |
No |
No |
No |
KL2012/02 |
No |
No |
No |
KL2012/03 |
No |
No |
No |
KL2014/01 |
No |
No |
No |
KL2014/03 |
No |
No |
No |
KL2015/02 |
No |
No |
No |
KL2015/03 |
No |
No |
No |
WSD
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful Prosecutions
(Yes/No) |
3/WSD/08 |
No |
No |
No |
6/WSD/08 |
No |
No |
No |
7/WSD/08 |
No |
No |
No |
8/WSD/08 |
No |
No |
No |
ArchSD
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
SS A501 |
No |
No |
No |
SS E517 |
Yes(1) |
No |
No |
SS C503 |
No |
No |
No |
SD E516 |
No |
No |
No |
EMSD
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
1020EM12A |
No |
No |
No |
2477EM14A |
No |
No |
No |
2487EM14W |
No |
No |
No |
HyD Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
HY/2014/18 |
No |
No |
No |
HY/2014/07 |
No |
No |
No |
MTR
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
1107 |
No |
No |
No |
1108 |
No |
No |
No |
1109 |
No |
No |
No |
1123 |
No |
No |
No |
1114 |
No |
No |
No |
HKHA
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
20150362 |
No |
No |
No |
COHL
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New
Kowloon Inland Lot No. 6516 & 6517 |
No |
No |
No |
K&K
Property Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New
Kowloon Inland Lot No. 6525 |
No |
No |
No |
KWH
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New
Kowloon Inland Lot No. 6526 |
Yes(2) |
No |
No |
Poly
Property Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
No |
No |
No |
|
No |
No |
No |
|
New Kowloon Inland Lot No. 6565 |
No |
No |
No |
Wheelock
Properties Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New
Kowloon Inland Lot No. 6541 |
No |
No |
No |
Century Basis Limited Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful Prosecutions
(Yes/No) |
New
Kowloon Inland Lot No. 6566 |
No |
No |
No |
Century Base Development
Limited Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New Kowloon Inland Lot No. 6567 |
No |
No |
No |
Leader Bright Limited
Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New
Kowloon Inland Lot No. 6557 |
Yes(3) |
No |
No |
HKCIM Projects
Contract No. |
Record of Complaint (Yes/No) |
Record of Warning (Yes/No) |
Notification of Summons and Successful
Prosecutions (Yes/No) |
New
Kowloon Inland Lot No. 6563 |
No |
No |
No |
New
Kowloon Inland Lot No. 6564 |
No |
No |
No |

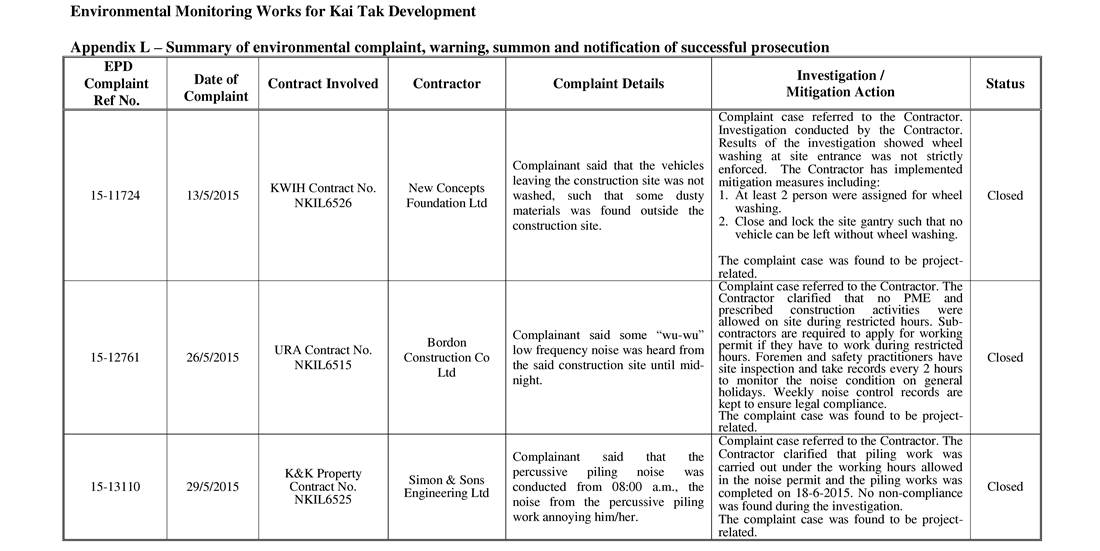

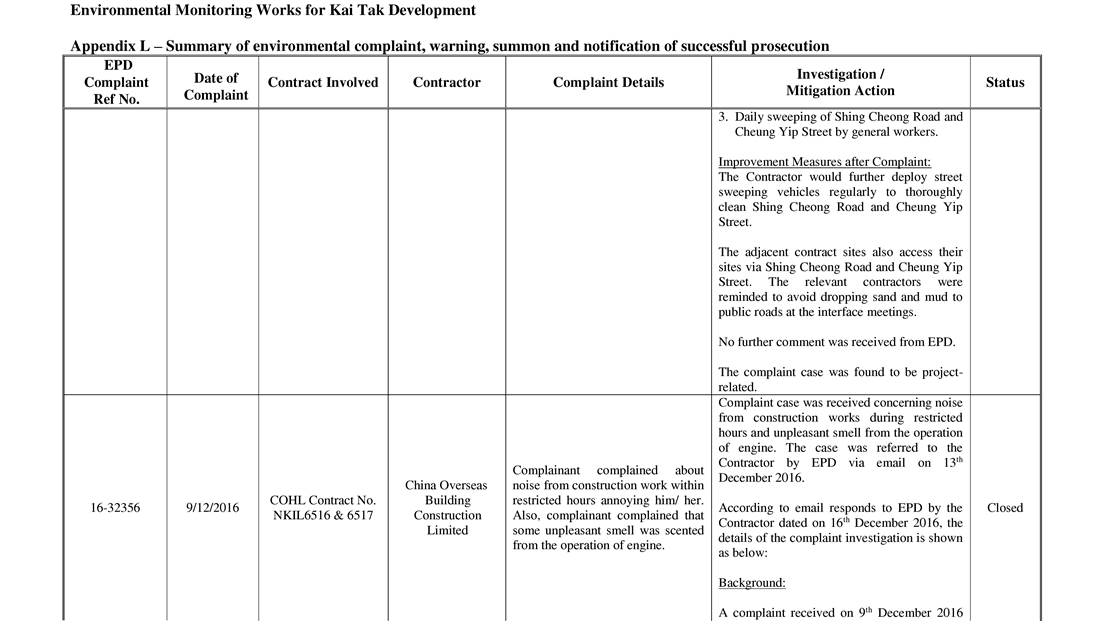

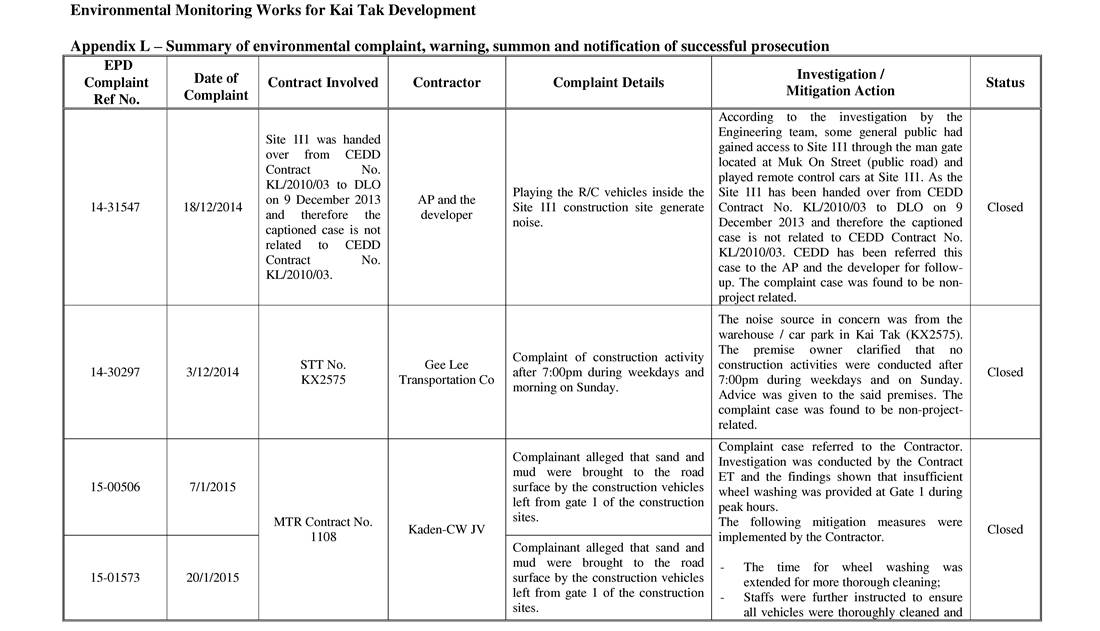

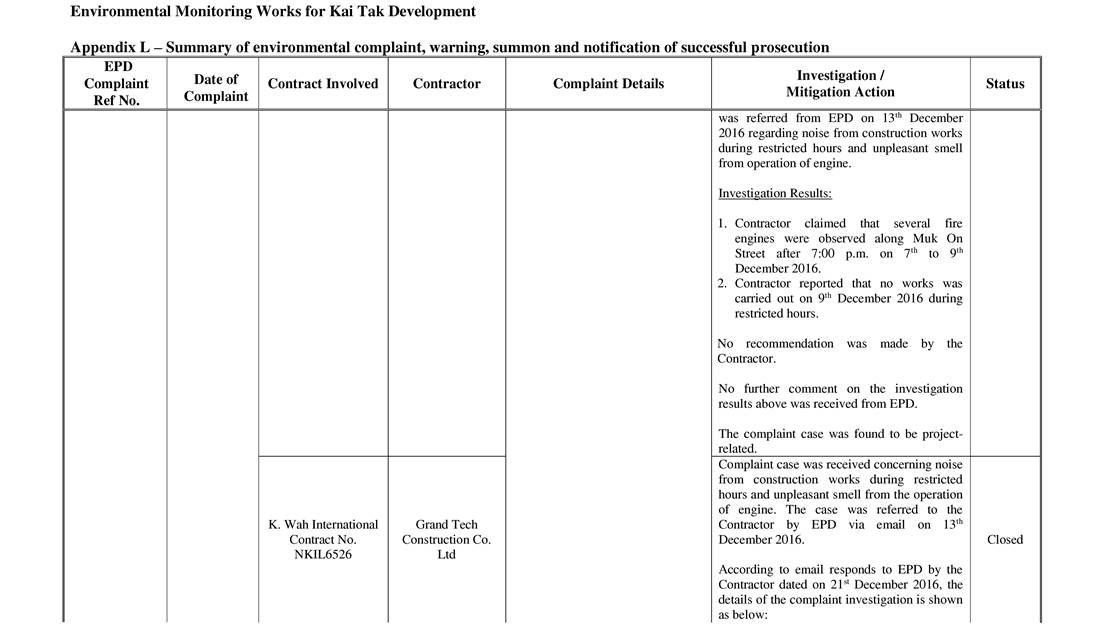

Note (1): Complaint case EPD ref no. 18-14685 on ArchSD project Contract
no.: SS E517
Note (2): Complaint case EPD ref no. 18-14107 on KWH project Contract
no.: NKIL 6526
Note (3): Complaint case EPD ref no. 18-09657 on Leader Bright Limited project
Contract no.: NKIL 6557.
Cumulative Statistics on Complaints,
Notification of Summons and Successful Prosecutions
Works Contract/ TGLA/ STT |
Record of Complaint |
Record of Warning |
Notification of Summons and Successful
Prosecutions |
Contract
No. KLN/2016/09 |
0 |
0 |
0 |
Works
Contract within KTD |
132 |
0 |
4 |
TGLA/
STT |
1 |
0 |
0 |
Environmental Monitoring Works for Kai Tak
Development Appendix L – Summary of environmental complaint,
warning, summon and notification of successful prosecution |
|||||||||||||
EPD Complaint Ref No. |
Date of Complaint |
Contract Involved |
Contractor |
Complaint Details |
Investigation / Mitigation Action |
Status |
|||||||

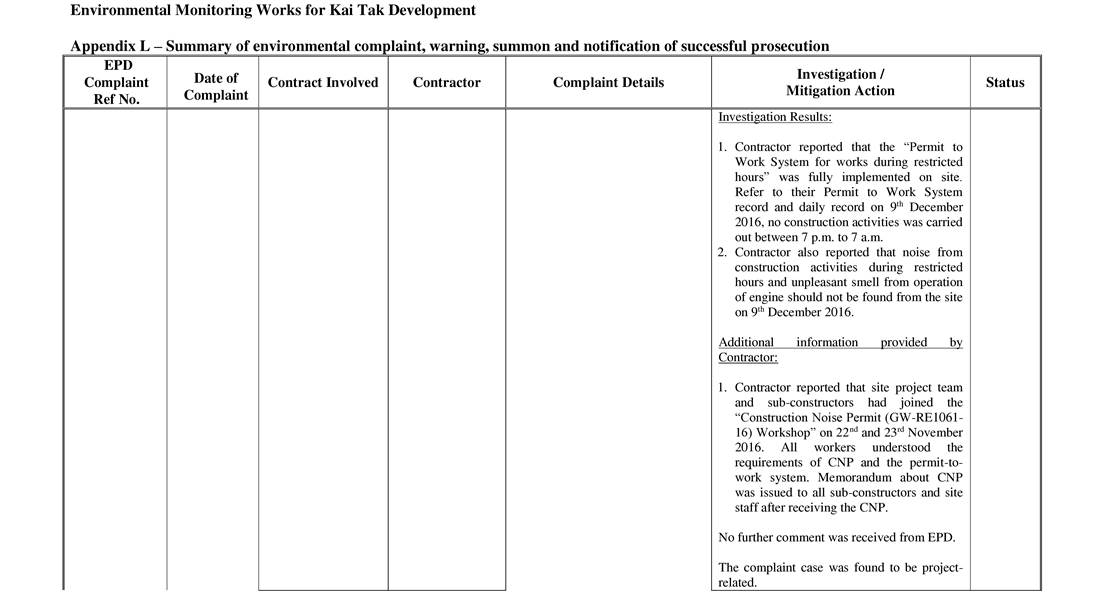

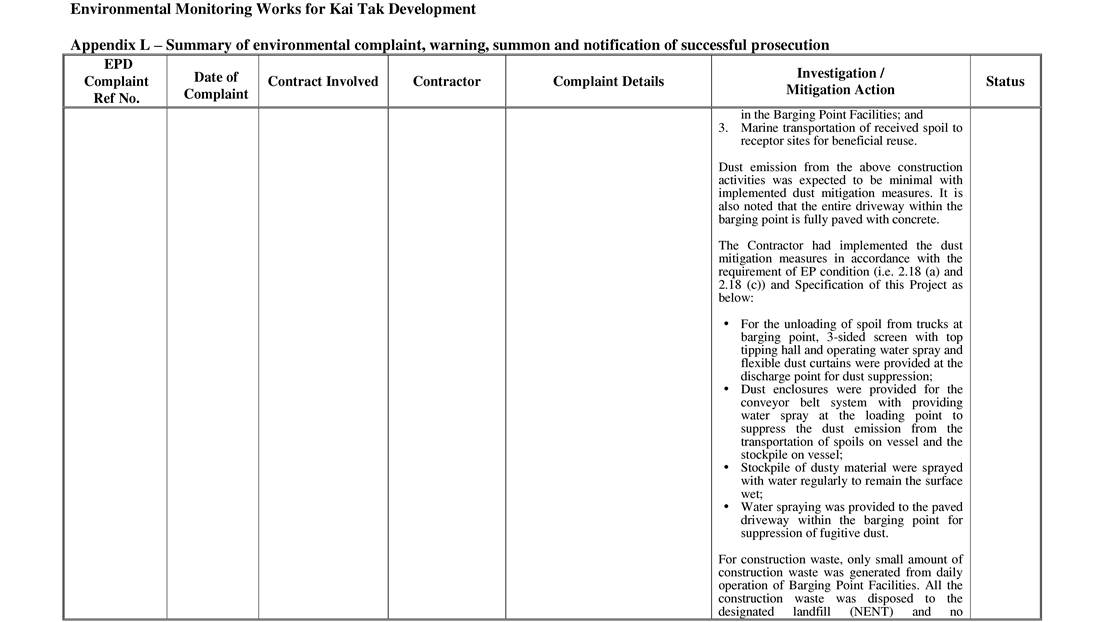

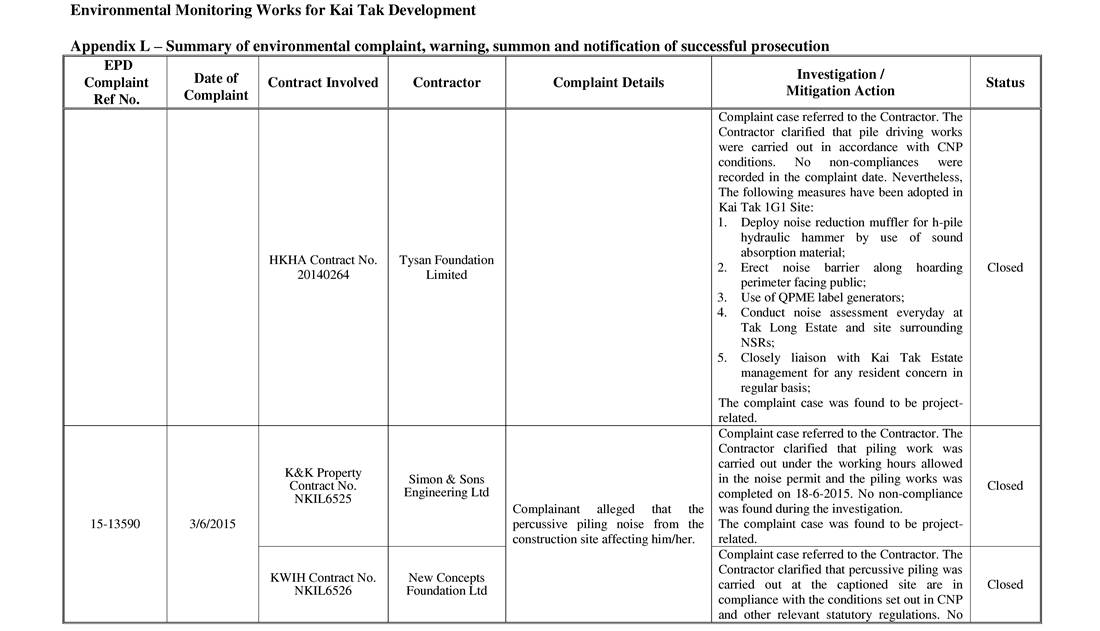

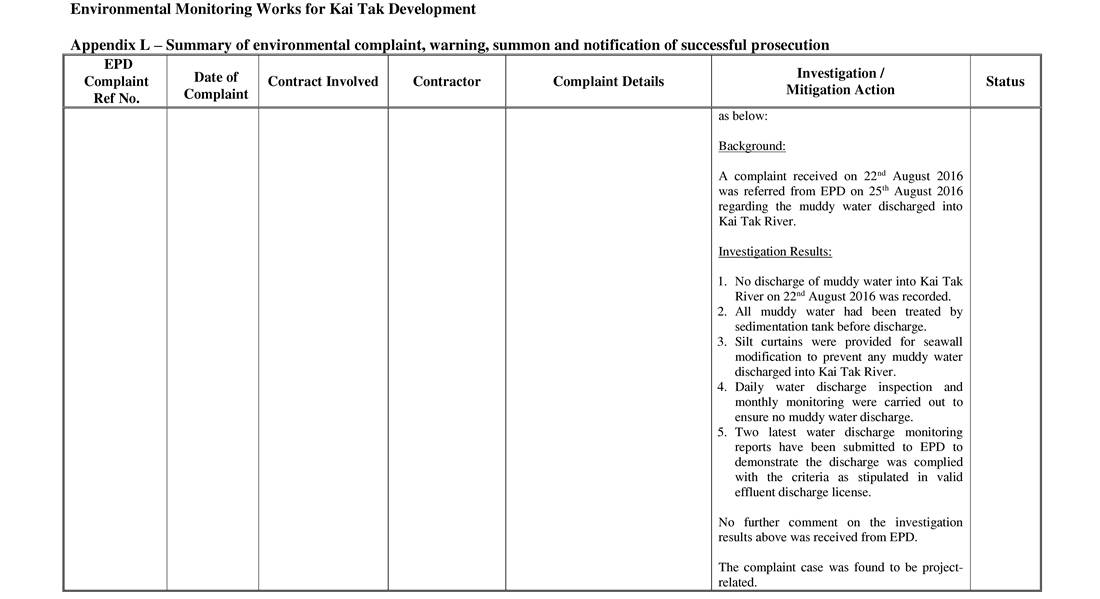

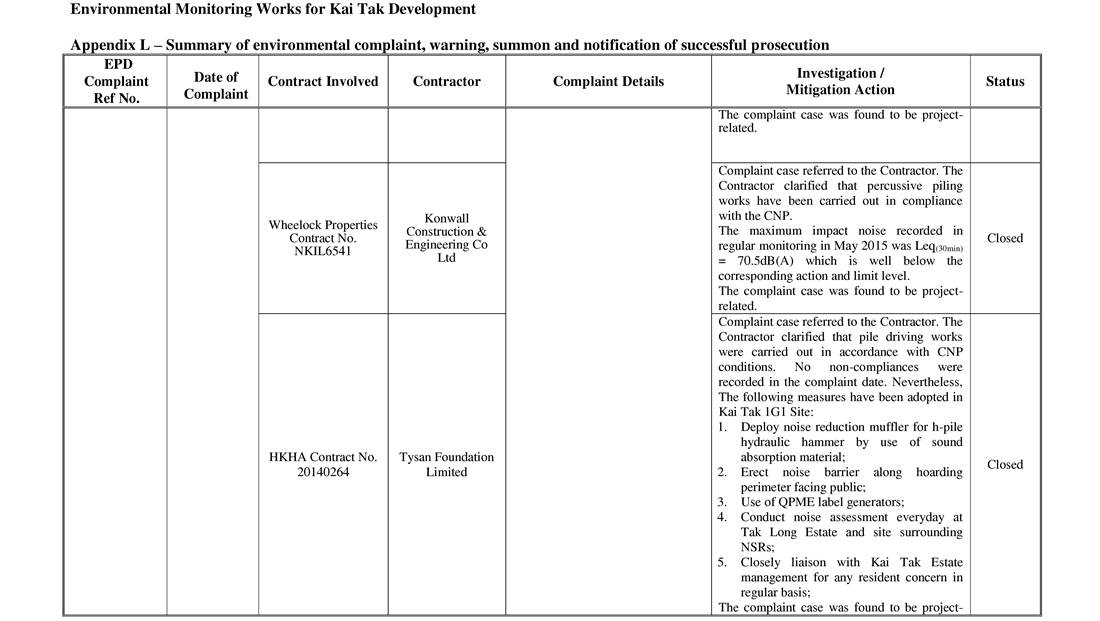

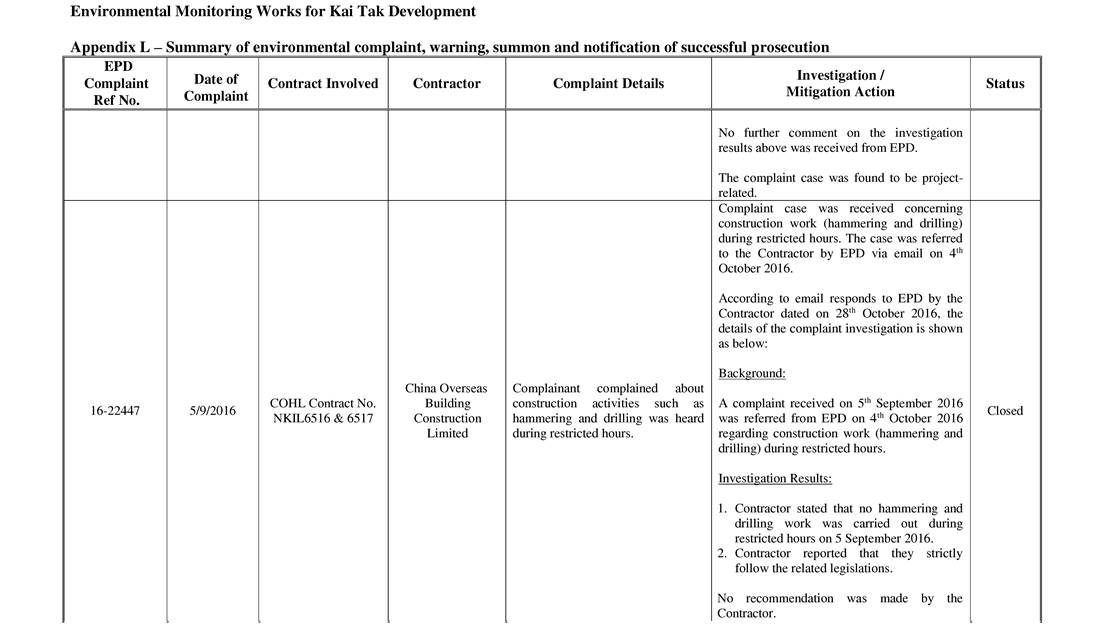

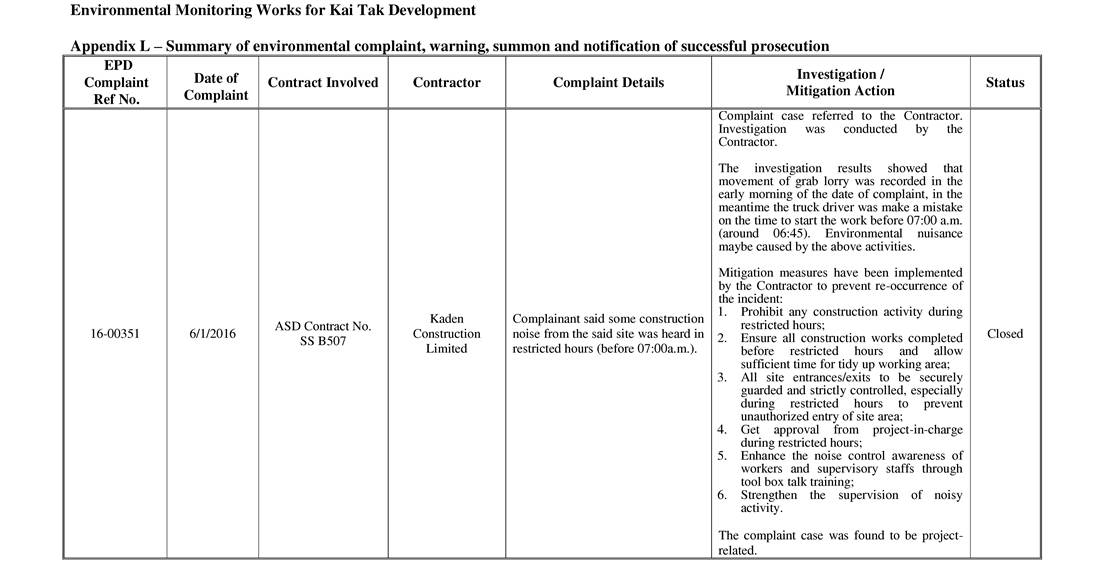

17-05215 |
23/02/2017 |
CEDD Contract No. KL/2012/02 |
Kaden Construction Limited |
Complainant
said he saw dump truck leaving the construction area beside Concorde Road
without washing and also the dusty road affecting his driving activities. |
Complaint case was
received concerning dust observed from the
construction site. The case was referred to the Contractor by EPD via email on
9th March 2017. According to the monthly survey form from
Contractor, the details of the complaint investigation is shown as below: Background: A complaint received on 23rd February 2017 was referred
from EPD on 9th March 2017 regarding dump truck leaving the
construction area without washing and dusty road affecting the complainant
driving activities. Follow-up Action: Contractor held toolbox talk to remind
truck drivers and workers to perform wheel-washing before leaving
construction area. Contractor had also increased the frequency of watering
road surface and street sweeper. No further comment was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||

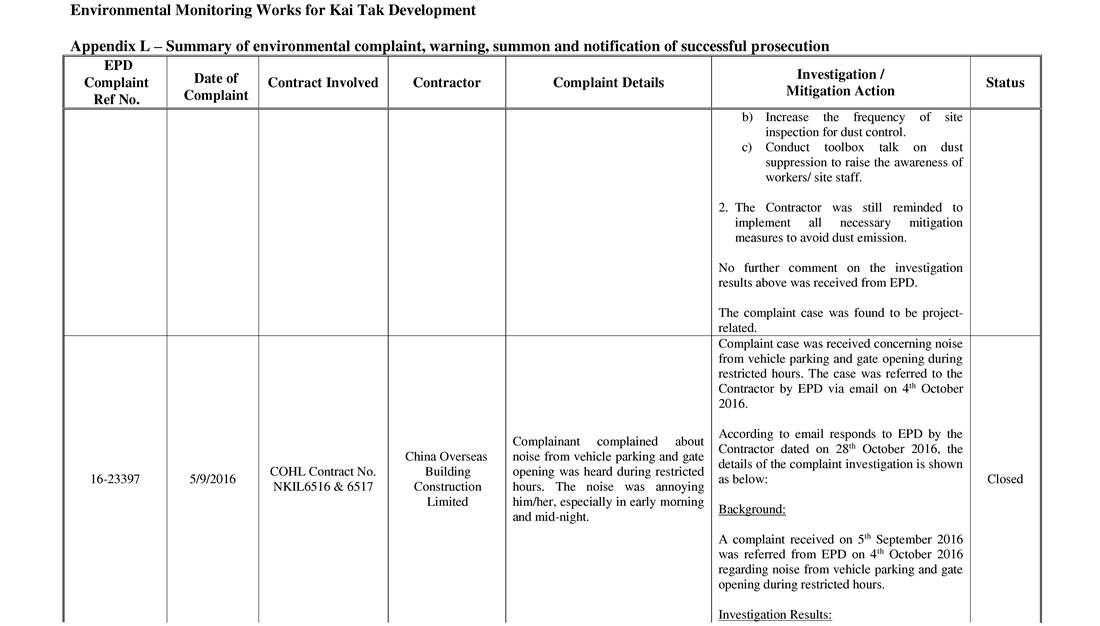

17-05606 |
28/02/2017 |
COHL Contract No. 6516&6517 |
China Overseas Building Construction Limited |
Complainant
quoted that drilling noise and hammering sound was heard at 2:00am and 6:00am
respectively from 啟德一號construction site. |
Complaint case was received concerning noise from construction works during the
restricted hours. The case was referred to the Contractor by EPD via email on 21st
March 2017. Background: A complaint received on 28th
February 2017 was referred from EPD on 21st March 2017 regarding
noise from construction site during restricted hours. Investigation
Results: Contractor
stated that no construction works were carried out in the mentioned period.
Contractor had also stated that they had ensured all works were carried out
at normal working hours. No
recommendation was made by the Contractor. No
further comment on the investigation results above was received from EPD. The
complaint case was found to be project related. |
Closed |
|||||||
17-08021 |
20/03/2017 |
ArchSD Contract No. SS E517 |
Hanison Construction Company Limited |
Complainant
complained about the dust emission from the excavation/ breaking in the
construction site of Muk Hung Street next to CLP substation (Kai Tak Site
1A-2). |
Complaint case was received concerning dust
emission from construction area. The case was referred to the Contractor by
EPD via email on 12th April 2017. According to the monthly survey form from Contractor,
the details of the complaint investigation is shown as below: Background: A complaint received on 20th
March 2017 was referred from EPD on 12th April 2017 regarding dust
emission from construction area. Follow-up Action: Contractor stated that they would take actions
to minimize dust emission, such as installation of automatic water spraying
system, cover construction materials by impervious sheeting, spray water
during breaking and excavation. No
further comment on the investigation results above was received from EPD.
|
Closed |
|||||||
17-08082 |
20/03/2017 |
K&K Property Contract No. NKIL6525 |
Hien Lee Engineering Company Limited |
Complainant
said noise from construction work (concreting) within restricted hours (after
7 p.m.) annoying him/ her. He/she said that he/ she found that some machine
was used in concreting work in restricted hours. |
Complaint case was received concerning noise
from construction site within restricted hours. The case was referred to the
Contractor by EPD via email on 12th April 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 20th
March 2017 was referred from EPD on 12th April 2017 regarding
noise from construction site within restricted hours Investigation Result: Contractor stated that concreting work was
finished before 17:35 on that day. All Powered Mechanical Equipments were
turned off, and no construction work was carried out during restricted hours. No
further comment on the investigation results above was received from EPD.
|
Closed |
|||||||

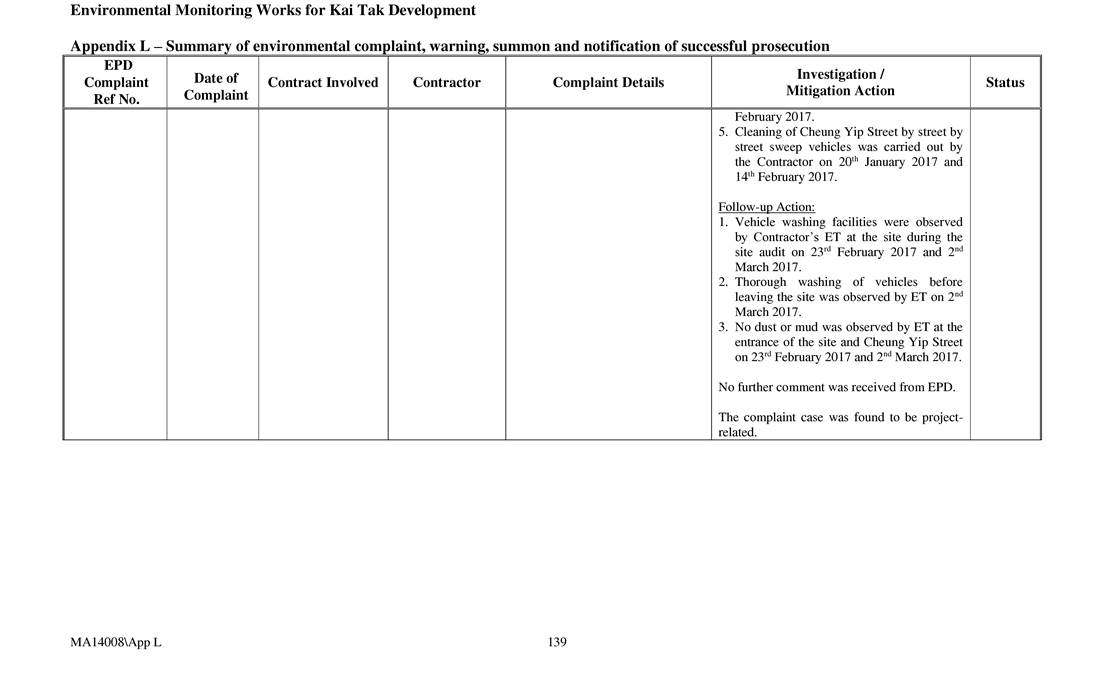

17-09999 |

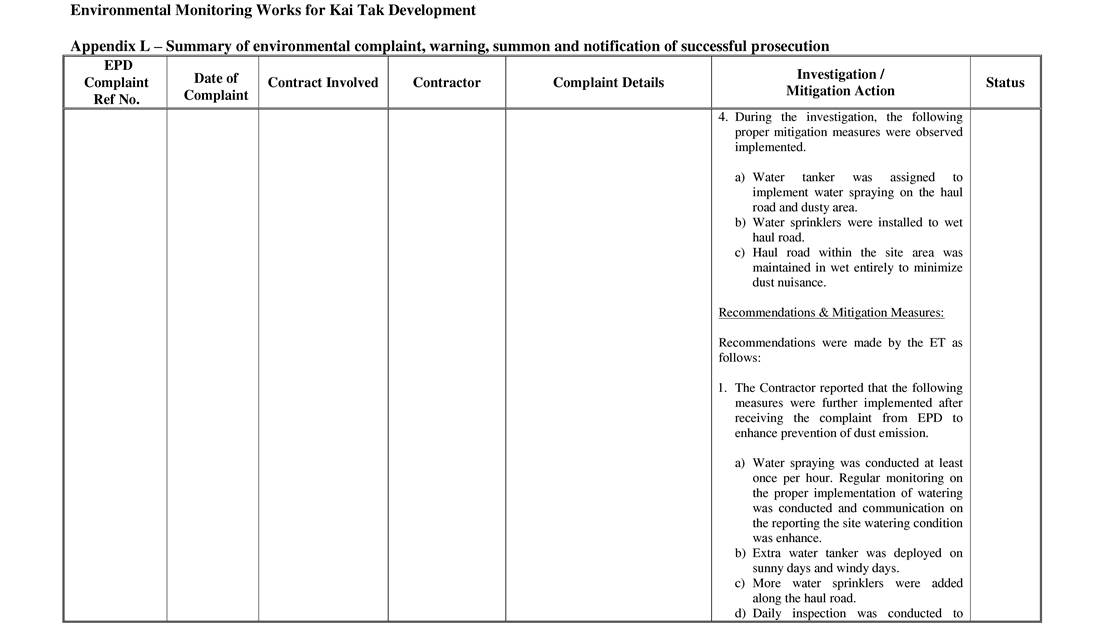

05/04/2017 |
CEDD Contract No. KL/2011/01 |
Chit Cheung Construction Company Limited |
Complainant
emphasized that dust emission was observed when vehicle running on the dry
surfaces outside the main haul road in the construction site in public
holidays. He requested dust suppression during holidays. |
Complaint case was received concerning dust
emission when vehicle running on dry surfaces outside the main haul road in
the construction site on public holidays. The case was referred to the Contractor
by EPD via email on 12 April 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: An environmental complaint received on 5 April
2017 by EPD was referred to the Contractor on 12 April 2017 regarding dust
emission when vehicle running on the dry surfaces outside the main haul road
during holidays. The complainant
requested dust suppression measures to be carried out during holidays. Investigation Results (before Complaint): 1. Water bowsers were
deployed to spray water to keep the haul roads moist to control dust emission
during working days. The frequency of watering was 6 times/day from 8:00 to
17:00 hr. 2. Other areas with
vehicles running on them are also watered as necessary during working days. 3. Sprinkler system was
also installed within the site to operate from 8:30 hrs. to 17:00 hrs. daily
including public holidays. 4. Since the commencement
of the Contract, all dump trucks must pass through the wheel washing bay
before leaving the Site and the dusty materials are covered by impervious
sheeting during transportation to prevent causing pollution to the public
roads. Improvement Measures (after Complaint): 1. Manual water spraying
as in interim measure has been arranged on areas with vehicles running on
them during public holidays, particularly during the Easter Holidays from 14 April
2017 to 17 April 2017. 2. In the long term,
water bowers would be deployed to keep the running surfaces moist to control
dust emission during public holidays where there are works and application
for Construction Noise Permit to operate water bowers during public holidays
has been made of EPD. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||
17-09968 |
11/04/2017 |

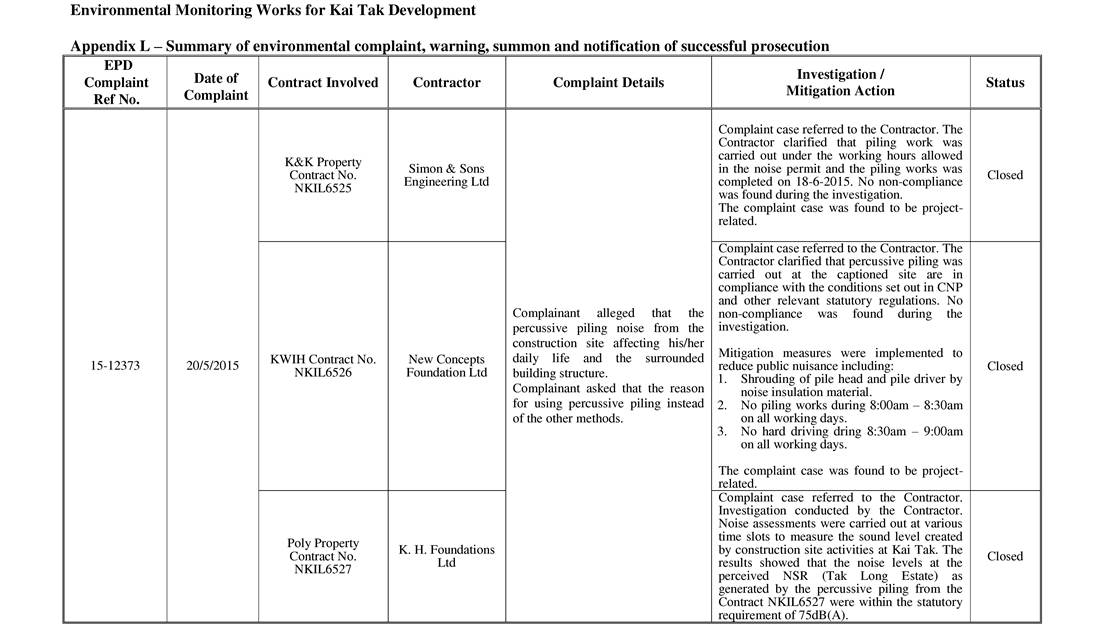

K&K Property Contract No. NKIL6525 |

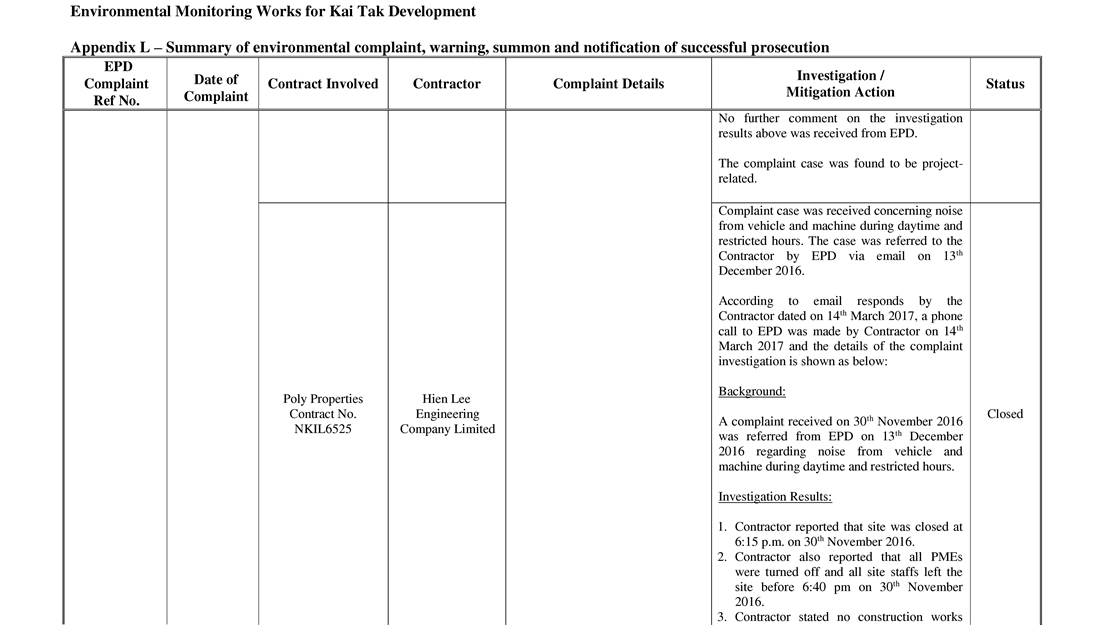

Hien Lee Engineering Company Limited |
Complainant
quoted the following issues about the construction sites adjacent to Tak Long
Estate: 1.
Construction noise was
heard before 7:00am of 5th April 2017. 2.
Ground breaking noise
was heard at 11:30pm of 7th April 2017. 3. Odour was scented intermittently which was
suspected sourced from these construction sites. |
Complaint case was received concerning noise
and odour emitted from construction site. The case was referred to the
Contractor by EPD via email on 18th April 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 11th
April 2017 by EPD was referred to the Contractor on 18th April
2017 regarding noise and odour emitted from construction area. Investigation Result: 1.
Contractor stated that according to their record of 5th
April 2017, no workers had entered the site until 7:30am and no construction
work was carried out. 2.
There were no ground breaking work on 7th April 2017 and no
workers remained at site after 7:30pm on that day. 3.
Regarding the odour problem, contractor stated that there was no fume
emission work during that period of time except minor welding works. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||

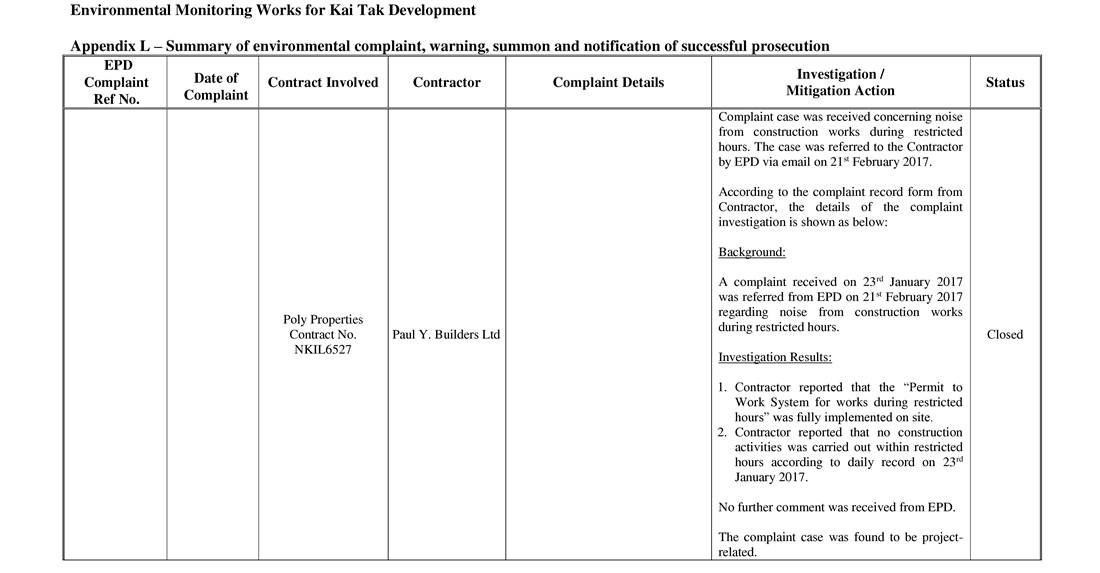

Poly Properties Contract No. NKIL6527 |
Paul Y. Builders Limited |
Complaint case was received concerning noise
and odour emitted from construction site. The case was referred to the
Contractor by EPD via email on 18th April 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 11th
April 2017 by EPD was referred to the Contractor on 18th April
2017 regarding noise and odour emitted from construction area. Investigation Result: 1.
Contractor stated that “Permit to Work System for works during
restricted hours” was fully implemented on site. Refer to the contractor’s Permit to
Work System record and daily record on 5th and 7th
April 2017, no construction activities were carried out between 7pm to 7am.
Thus noise and odour of mechanical equipment from site should not be found
from site before 7am on 5th April 2017 and 11:30am on 7th
April 2017. 2.
Contractor stated that site project team and sub-constructors had
joined the “Construction Noise Permit (CNP) (GW-RE0056-17) Workshop” on 14th
February 2017 and 21st February 2017. They fully understood the requirements
of CNP and the permit-to-work system. Memorandum about CNP was issued to all
sub-constructors and site staff after received the CNP. No further comment on the investigation
results above was received from EPD.
|
|
||||||||||
Closed |
|||||||||||||
|
Wheelock Properties Contract No. NKIL6541 |
Hip Hing Construction Company Limited |
Complaint case was received concerning noise
and odour emitted from construction site. The case was referred to the
Contractor by EPD via email on 18th April 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 11th April
2017 by EPD was referred to the Contractor on 18th April 2017
regarding noise and odour emitted from construction area. Follow-up Action: Contractor would adopt preventive actions
to fulfill legal requirements and prevent causing any environmental nuisance
to the public. No further comment on the investigation results above was received
from EPD. The complaint case was found to be project related. |
Closed |
|||||||||
COHL Contract No. NKIL6516&6517 |
China Oversea Building Construction Limited |
According to email
response to EPD by the Contractor, the details of the complaint investigation
are as below: Background: A complaint received
on 11th April 2017 by EPD was referred to the Contractor on 18th
April 2017 regarding noise and odour emitted from construction area. Investigation Result: 1.
Contractor stated that no construction works were found on 5th
April 2017 before 7:00a.m. And no breaking work trade was carried out on 7th
April 2017. 2.
Contractor also stated that there were no odours emitted from the
construction site. No further comment on
the investigation results above was received from EPD.
|
Closed |
||||||||||

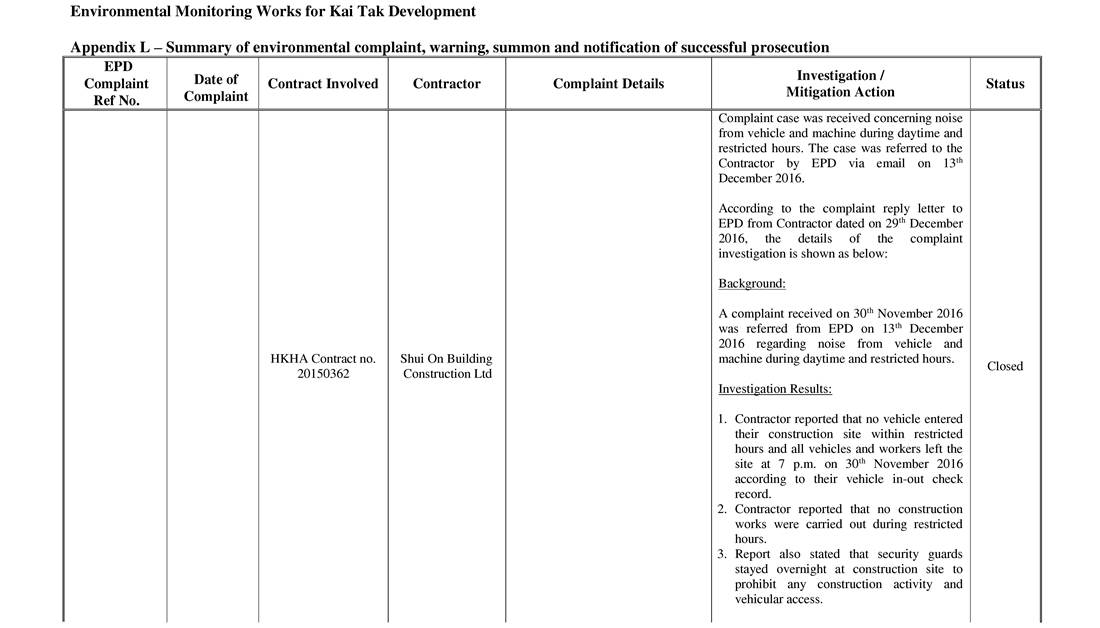

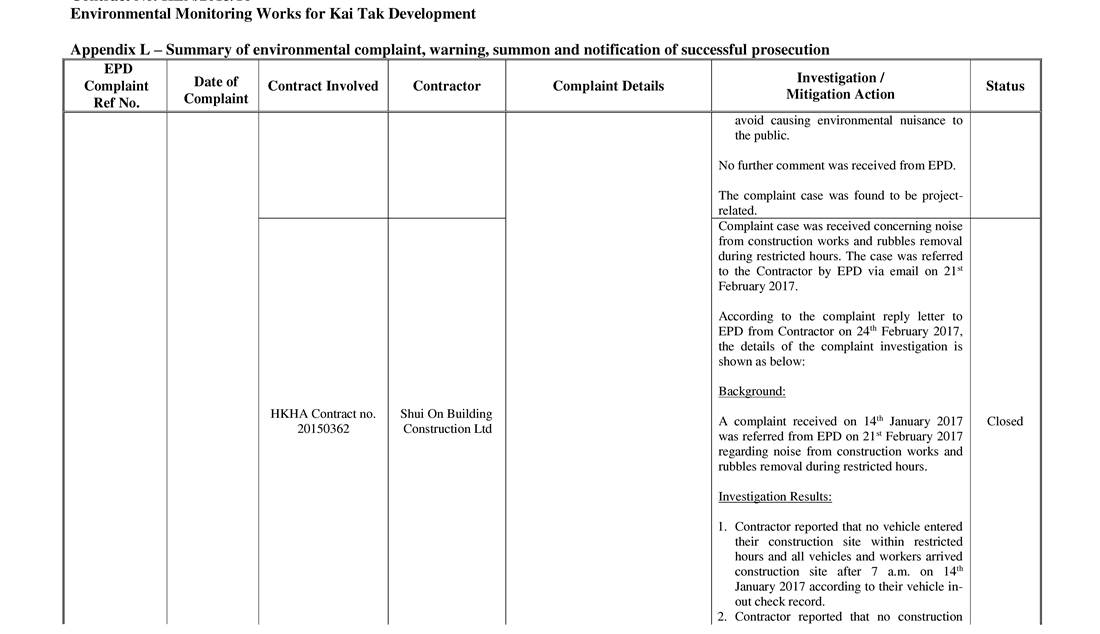

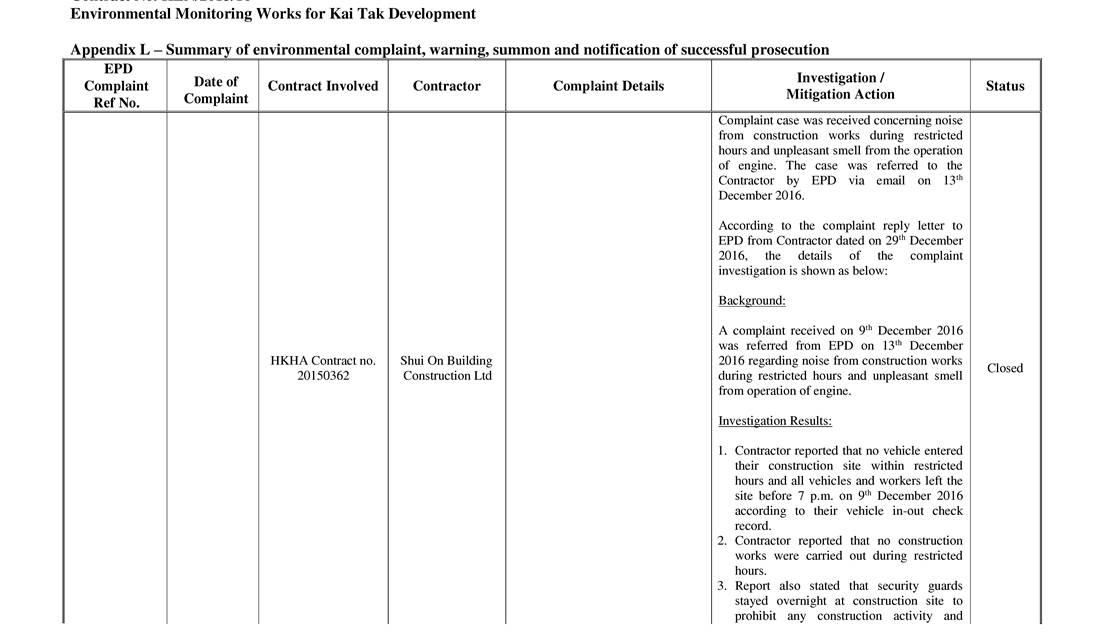

HKHA Contract No. 20150362 |
Shui On Building Construction Limited |
Complaint case was received concerning noise
and odour emitted from construction site. The case was referred to the
Contractor by EPD via email on 18th April 2017. According to email
response to EPD by the Contractor, the details of the complaint investigation
are as below: Background: A complaint received
on 11th April 2017 by EPD was referred to the Contractor on 18th
April 2017 regarding noise and odour emitted from construction area. Investigation Result: 1.
After checking daily vehicle in-out check record, contractor stated
that there were no vehicle entered the construction site before 7am and no construction
work was carried out during restricted hours. Security guards stay on site
24-hours and had clear instructions of prohibiting any construction activity
and vehicular access during restricted hours. 2.
Contractor had checked the workers’ daily entry and leaving record;
and no worker stayed behind for construction works within the restricted
hours. Contractor also had permit-to-work system implemented, all workers
stayed behind for construction works had to get permission from
superintendent, but not including sound-making works and prescribed
construction works. 3.
For the nuisance of odour, subcontractor was responsible for keeping
the site hygiene and removing the domestic waste every day in order to avoid
rubbish accumulation and odour generation. In addition, three generators and
the bucket for domestic waste storage were placed as far as possible away
from the Tak Long Estate, to minimize the nuisance to the neighbourhood. 4.
Contractor stated that complying with the Noise Control Ordinance (CAP
400) was one of their mandatory requirements; after receiving the notification
from EPD, contractor had reminded again all their subcontractors to get rid
of any construction works in restricted hours. An ad-hoc meeting had been
held for project planning review and to remind their onsite staffs (including
security guards and workers) the environmental legislations, in order to increase
their environmental awareness and ensure any construction activities within
restricted hours were strictly prohibited. No further comment on the investigation
results above was received from EPD.
The complaint case was found to be project
related. |
Closed |
||||||||||
|
|

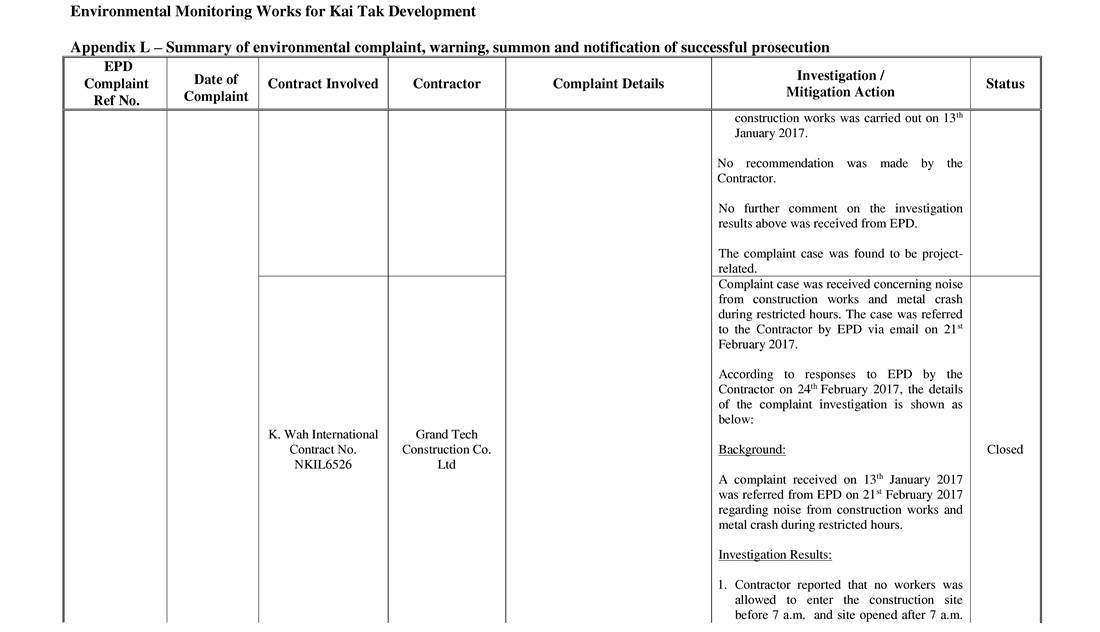

K. Wah International Contract No. NKIL6526 |
Grand Tech Construction Co. Ltd. |
Complaint case was received concerning noise
and odour emitted from construction site. The case was referred to the
Contractor by EPD via email on 5th May 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 17th April
2017 by EPD was referred to the Contractor on 5th May 2017
regarding noise and odour emitted from construction area. Investigation Result: Contractor stated that all workers started
construction work after 7am and no workers stayed or worked in construction
site after 7pm, thus there should not had ground breaking sound from their construction
site at 11pm. Regarding the odour, contractor stated that there were no
irritation chemical used in construction and no vehicular activities before
7am or after 7pm. No further comment on the investigation
results above was received from EPD.
|
Closed |
||||||||
17-09370 |
29/03/2017 |
ArchSD Contract No. SS E517 |
Hanison Construction Company Limited |
Complainant
said that he/ she heard the noise from construction activities before 7am in
normal working days (Monday to Saturdays) and after 7am on Sunday. The
traffic for engineering work was annoying him/ her. |
Complaint case was received concerning
noise from construction activities during restricted hours. The case was
referred to the Contractor by EPD via email on 19th April 2017. According to the monthly survey form from
Contractor, the details of the complaint investigation is shown as below: Background: A complaint received on 29th
March 2017 by EPD was referred to the Contractor on 19th April
2017 regarding noise from construction activities. Investigation Result: Contractor replied EPD that no construction
activities at that period of time. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-08510 |
23/03/2017 |
MTR Contract 1114 |
Paul Y. Construction Company Limited |
Complainant
said that he/she heard the noise from loading/unloading activities in the
early morning (about 4a.m.) inside the site. |
Complaint case was received concerning
noise during restricted hours. The case was referred to the Contractor by EPD
via email on 11th April 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 23rd
March 2017 by EPD was referred to the Contractor on 11th April
2017 regarding noise during restricted hours. Follow-up Action: 1. All construction activities during restricted
hours needed the approval of Project Manager and environmental officer of
contractor through applying in-house permit-to-work. 2. All personnel must be registered for
work before entering the site during restricted hours. 3. All site entrance/ exits were securely
guided and strictly controlled, especially during restricted hours to prevent
unauthorized entry of site area. 4. Contractor stated that they would
provide sufficient training, workshop and spot check for carrying out
construction works during restricted hours. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-11372 |
17/04/2017 |
COHL Contract No. NKIL6516&6517 |
China Oversea Building Construction Limited |
Complainant quoted construction
noise was heard from「啟德一號」and
K.City construction
sites in public holiday. |
Complaint case was received concerning
noise from construction activities during public holiday. The case was
referred to the Contractor by EPD via email on 2nd May 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 17th
April 2017 by EPD was referred to the Contractor on 2nd May 2017
regarding noise from construction activities in public holiday. Investigation Result: Contractor stated that there were no constructions
works assigned and carried out during holidays. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
|
|

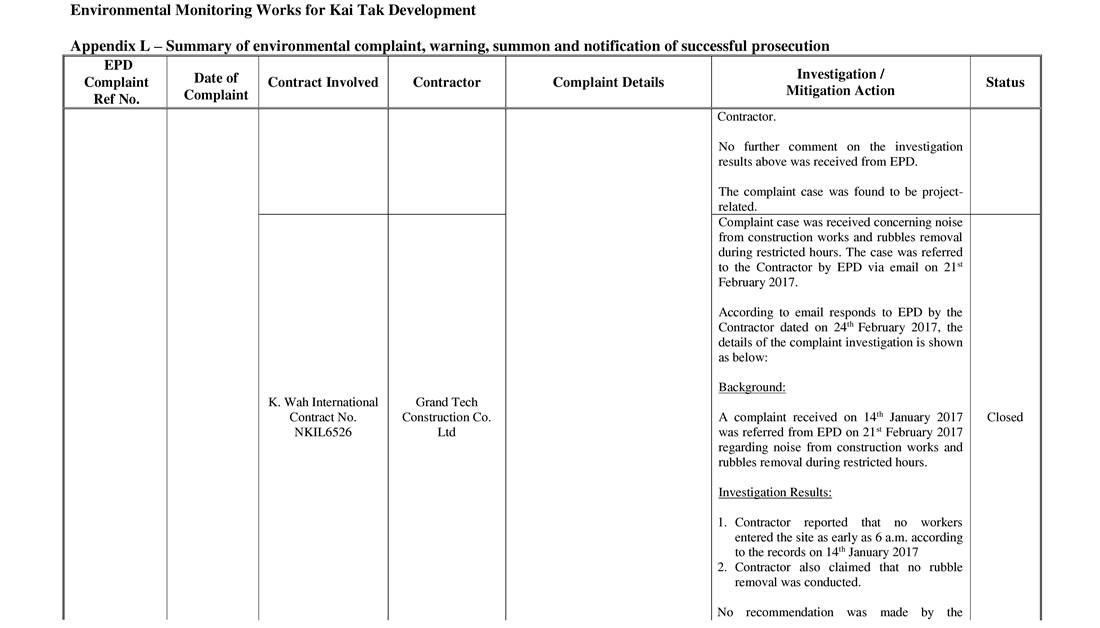

K. Wah International Contract No. NKIL6526 |
Grand Tech Construction Co. Ltd. |
|
Complaint case was received concerning
noise from construction activities during public holiday. The case was
referred to the Contractor by EPD via email on 5th May 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 17th
April 2017 by EPD was referred to the Contractor on 5th May 2017
regarding noise from construction activities in public holiday. Investigation Result: No further comment on the investigation
results above was received from EPD. The complaint case was
found to be project related. |
Closed |
|||||||
17-14653 |
12/05/2017 |
ArchSD Contract No. SS E517 |
Hanison Construction Company Limited |
Complainant
said some strong lighting were directly illuminated to the surrounded
buildings at Kai Ching Estate. |
Complaint case was received concerning
strong lightings from construction area. The case was referred to the
Contractor by EPD via email on 31st May 2017. According to the monthly survey form from
the Contractor, the details of the complaint investigation are shown as
below: Background: A complaint received on 12th May
2017 by EPD was referred to the Contractor on 31st May 2017
regarding strong lightings from construction area. Follow-up Action: Contractor had taken action to change the

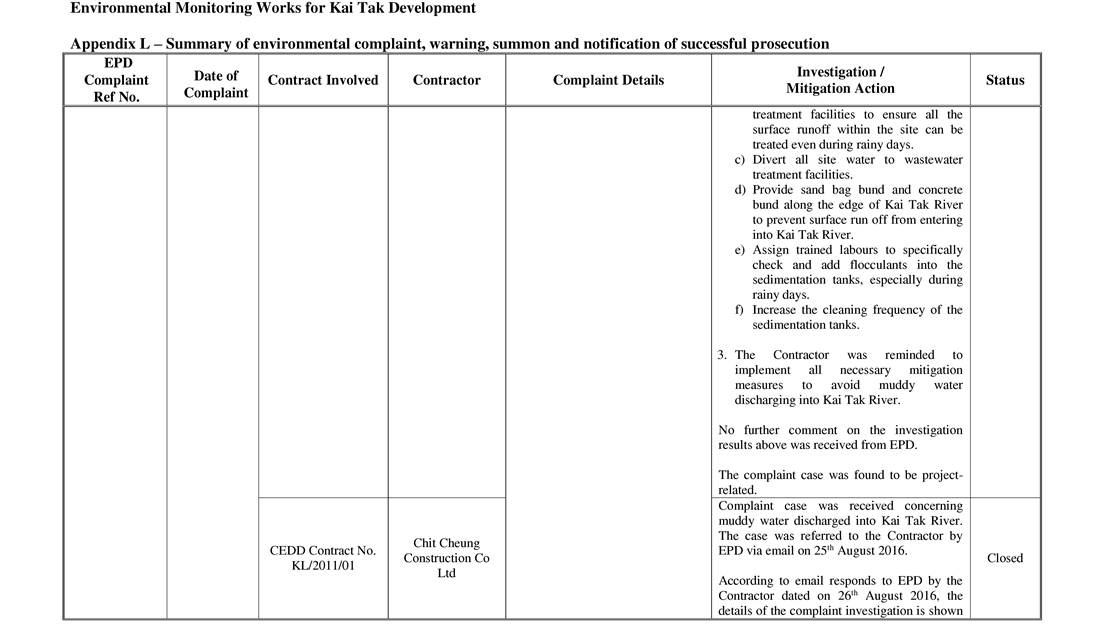

position of solar light on container office to avoid lighting pollution. No further comment on the investigation results
above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-16635 |
29/05/2017 |
CEDD Contract No. KL/2011/01 |
Chit Cheung Construction Company Limited |
Complainant
about muddy water discharged to Kai Tak River after heavy rainfall. |
Complaint
case was received concerning muddy water discharge to Kai Tak River.
The case was
referred to the Contractor by EPD via email on 8th
June 2017. According to the response to EPD by the Contractor via email, details of the complaint investigation are as
below: Background: An environmental
complaint received on 29th May 2017 was referred from EPD on 8th
June 2017 regarding muddy water discharge to Kai Tak
River after heavy rainfall. Investigation
Results (before Complaint): 5.
Sand bag barriers were placed along the nullah
bank. 6.
Sedimentation tanks and pumps were provided to
treat the site runoff before discharge. 7.
According to the site records and the records
from Hong Kong Observatory, before 29th May 2017, rainfall was
recorded on 24th May 2017 during which Amber, Red and Black
Rainstorm Warning Signals were issued from 06:40 to 15:00 hr with a total
rainfall of 224.5mm recorded. 8.
Possibly due to the heavy rainfall having
exceeded the capacity of the existing preventive measures, some site runoff
might overflow into the nullah. Improvement Measures
after Complaint: 3.
To enhance the overflow preventive
measures, the provision of sand bag barrier was extended to the edge of haul
roads. 4.
Additional sand bag patches with
cement forming an earth bund together with additional water-filled barriers
were placed along the edges of nullah to prevent site runoff from flowing
into the nullah; 5.
An additional sedimentation tank was
provided to provide further treatment of site runoff; 6.
The river bank slopes at mid-stream
were properly covered by tarpaulin sheet to prevent erosion of soil slope. No further comment
on the investigation results above was received from EPD. The complaint case was found to
be |
Closed |
|||||||
17-16288 |
26/05/2017 |
HKHA Contract No. 20150362 |
Shui On Building Construction Limited |
Complainant
said noise construction within restricted hours annoying him/ her. He/ she
said that hammering noise was heard till 3-4 a.m. Complainant
also complained about the noise from the work site on Sunday and public
holidays. |
Complaint case was received concerning noise
from construction site during restricted hours. The case was referred to the
Contractor by EPD via email on 13th June 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 26th May
2017 by EPD was referred to the Contractor on 13th June 2017
regarding noise from construction site during restricted hours. Investigation Result: 1.
Contractor stated that they did not allow workers to stay overnight on
site, all workers was required to leave before 7pm. Hence there should be no
construction work carried out during restricted hours. There were also
security guards stayed on site around the clock in order to prevent any
workers from staying on site during restricted hours. Security team also had
clear instructions on prohibiting any construction activities and vehicular
access during restricted hours, 2.
Contractor also had permit-to-work system implemented, all workers
wanted to stay behind for construction works had to get permission from
superintendent. 3.
Contractor had stated complying with the Noise Control Ordinance (CAP
400) is one of their mandatory requirement. After receiving the notification
from EPD, the contractor had once again reminded all their subcontractors to
get rid of any construction works in restricted hours. An ad-hoc meeting had
been held for project planning review and to remind their onsite staffs
(including security guards and workers) the environmental legislations, in
order to increase their environmental awareness and ensure all construction
activities within restricted hours were strictly prohibited. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||
17-18162 |
12/06/2017 |
ArchSD Contract No. SS C503 |
Hsin Chong – Build King Joint Venture |
Complainant
said that piling noise was heard before 08:00am on Saturday. |
Complaint case was received concerning
noise from piling work during restricted hours. The case was referred to the
Contractor by EPD via email on 20th June 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 12th
June 2017 by EPD was referred to the Contractor on 20th June 2017
regarding piling noise from construction site during restricted hours. Follow-up Action: Contractor had the following noise mitigation
measure implemented 1. Cover of hammer shield 2. Provision of noise barrier at site
hoarding 3. Provision of noise enclosure for piling Contractor had also ensured all the
mitigation measure were in place during piling period and all the piling
works were conducted after 8:00am as required under the CNP. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||
17-18645 |
15/06/2017 |
ArchSD Contract No. SS C503 |
Hsin Chong – Build King Joint Venture |
Complainant
said that piling noise was heard in normal working days from 08:00am to 07:00
pm instantaneously. He /she also said some construction noise was heard in
restricted hours (after 7pm). |
Complaint case was received concerning
noise from construction area during restricted hours. The case was referred
to the Contractor by EPD via email on 20th June 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 15th
June 2017 by EPD was referred to the Contractor on 20th June 2017
regarding noise from construction area during restricted hours. Follow-up Action: Contractor had the following noise mitigation
measure implemented 1. Cover of hammer shield 2. Provision of noise barrier at site
hoarding 3. Provision of noise enclosure for piling Contractor had also ensured all the
mitigation measure were in place during piling period and all the piling
works were conducted within the piling period required under the CNP. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||
17-18943 |
19/06/2017 |
ArchSD Contract No. SS A501 |
China State – Shun On Joint Venture |
Complainant
said noise was heard from the site on Sunday/ public holidays and after 23:00
in normal working days. |
Complaint case was received concerning
noise from construction site during public holidays. The case was referred to
the Contractor by EPD via email on 28th June 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 19th
June 2017 by EPD was referred to the Contractor on 28th June 2017
regarding noise from construction site during public holidays. Follow-up Action: Contractor had promised to tighten the
monitoring system for noise in restricted time, and would ensure the site
would be in compliance with the requirement of Noise Control Ordinance. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||
17-22036 |
13/07/2017 |
ArchSD Contract No.: SS C503 |
Hsin Chong – Build King Joint Venture |
1.
Complaint said that
piling noise was heard in his/ her home located at Kai Ching Estate in normal
working days. He/ She also said 5 piling machines were conducting the piling
work. 2.
Complaint also wanted
to know when would the piling work complete. He/ She also want to know if any
addition preventive measures were taken place for the construction work. |
Complaint case was received concerning
piling noise from construction site. The case was referred to the Contractor
by EPD via email on 25th July 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 13th
July 2017 by EPD was referred to the Contractor on 25th July 2017
regarding piling noise from construction site. Follow-up Action: Contractor stated they had various noise
mitigation measures implemented on site including: 1. Noise screen had
been set up on hoarding facing noise sensitive receivers. Contractor would
consider to set up noise screen towards Kai Ching Estate. 2. Hanging up noise
enclosure during piling. 3.
Hammer shield had been provided for each piling head. Contractor also stated that piling work would
be finished by the end of December 2017. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||

17-23526 |
18/07/2017 |
CEDD Contract No. KL/2012/02 |
Build King Construction Limited |
Complainant
complained about the muddy water discharged in Kai Tak River. |
Complaint was received concerning muddy
water discharged into Kai Tak River. The case was referred to the Contractor
by EPD via email on 2nd August 2017. According to the investigation conducted by
the Contractor’s ET, the details of the complaint investigation are as below: Background: A complaint received on 18th
July 2017 by EPD was referred to the Contractor on 2nd August 2017
regarding muddy water discharged into Kai Tak River. Investigation Results: According to the contract’s ET’s response,
there were no construction works being carried out at the contractor’s site on
the date of complaint. The site area was used for storing C&D
materials. Mitigation Measures: 1.
Provided sand bag bund around the perimeter of the site to prevent
overflow of surface runoff. 2.
Covered all existing C&D stockpile stored within the site. 3.
Covered the drainage outlet with geotextile filter. 4.
Secured the geotextile membrane at the drainage gully with concrete
block. Follow-up Actions: Dye test was conducted to trace the drainage
outlet from the site, results showed that the drainage/seepage within site premises would
not flow via the drainage outlets to concerned area of Kai Tak River. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
|
|
MTR Contract No. SCL1109 |
Samsung – Hsin Chong Joint Venture |
|
Complaint was received concerning muddy
water discharged into Kai Tak River. The case was referred to the Contractor
by EPD via email on 2nd August 2017. According to Contractor’s EM&A report,
the details of the complaint investigation are as below: Background: A complaint received on 18th
July 2017 by EPD was referred to the Contractor on 2nd August 2017
regarding muddy water discharged into Kai Tak River. Site Activity Summary: Base on the site record on 18 July 2017,
internal transfer of soil to To Kwa Wan Station was conducted. Action taken/ To be taken: 1.
The exposed and idle stockpiles had been covered with sheeting. 2.
The stockpiles had been enclosed with concrete boxes and steel
hoarding, and the rims of steel hoarding were sealed with sandbags and
renovated. 3.
Pit and sedimentation tank was deployed to treat site runoff. No further comment on the investigation
results above was received from EPD.
|
Closed |
|||||||
17-23390 |
25/07/2017 |
HKHA Contract No. 20150362 |
Shui On Building Construction Limited |
Complainant
said some concrete and dusty material such as ash was emitted from the contractor’s
construction site to ‘De Novo’. |
Complaint was received concerning dusty
materials emitted from construction site. The case was referred to the
Contractor by EPD via email on 7th August 2017. According to email response to EPD by the
Contractor, the details of the complaint investigation are as below: Background: A complaint received on 25th
July 2017 by EPD was referred to the Contractor on 7th August 2017
regarding dusty materials emitted from contractor’s construction site. Investigation Results: According to the Contractor, their dust
monitoring records showed no record of exceedance in recent months. Follow-up Actions: Contractor would keep monitoring the
condition of ambient air. Contractor would also review their operational
procedures in order to minimize nuisance to the neighborhood. No further comment on the investigation results
above was received from EPD.
|
Closed |
|||||||
17-30192 |
12/09/2017 |
ArchSD Contract No. SS E517 |
Hanison Construction Company Limited |
Complainant
complained about the excessive noise generated from hydraulic hammer &
drop hammer operation from construction site. |

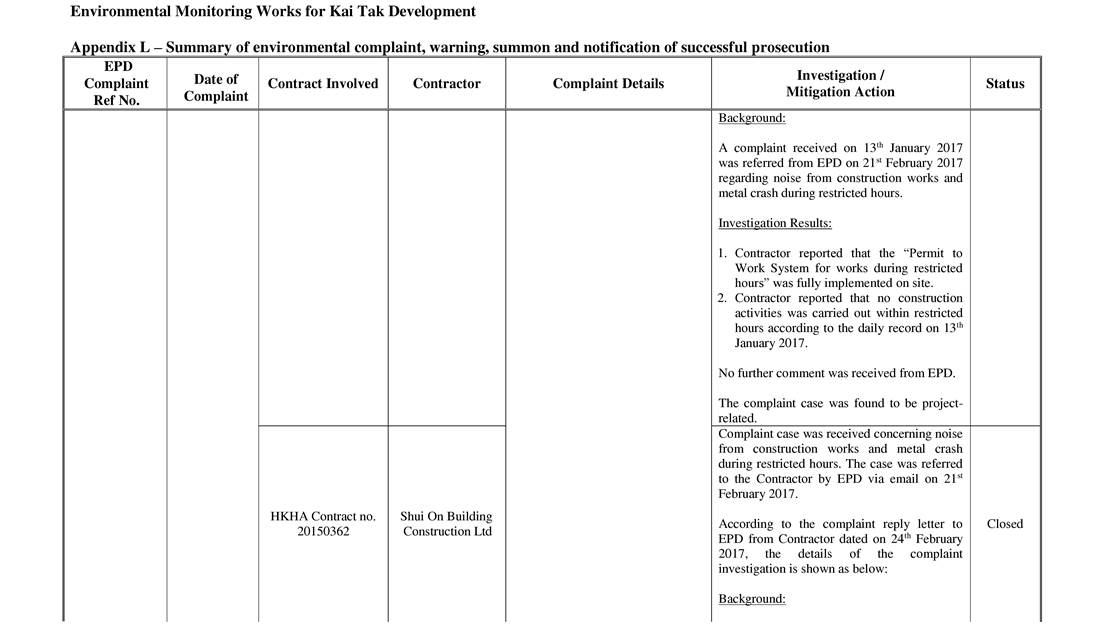

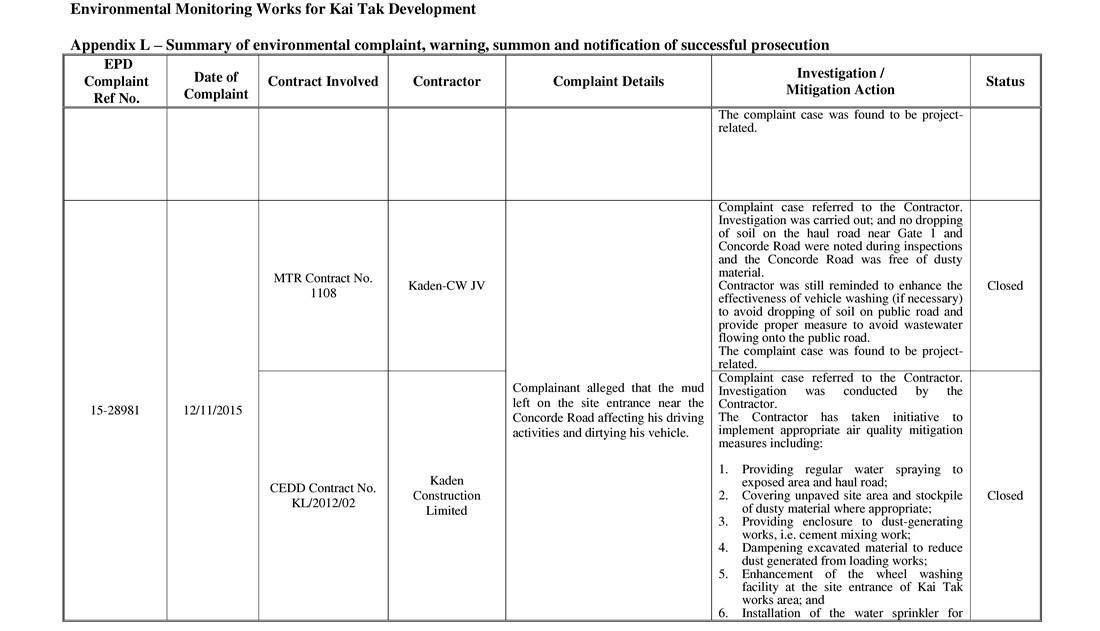

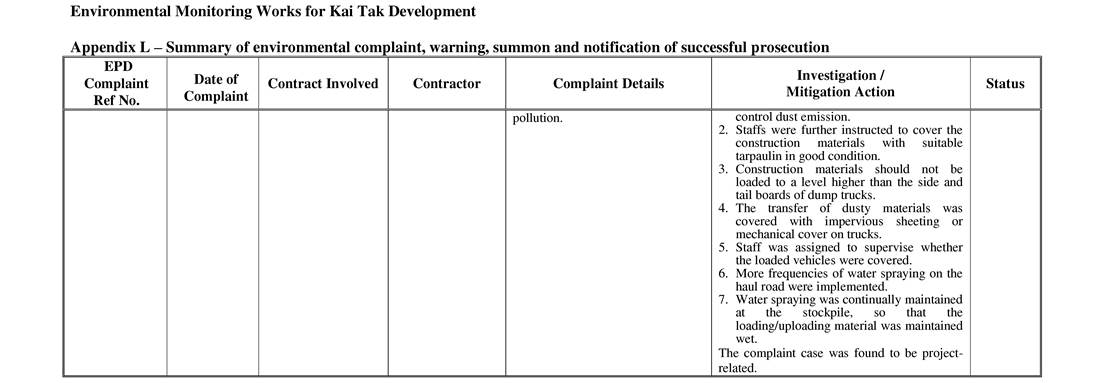

Complaint was received concerning noise generated from construction
site. The case was referred to the Contractor by EPD via email on 15h
September 2017. According to email response to EPD by the Contractor, the details of
the complaint investigation are as below: Background: A complaint received on 12th September 2017 by EPD was
referred to the Contractor on 15th September 2017 regarding noise generated
from construction site. Investigation Result: According to the Contractor’s reply to EPD,
Contractor advised that they had complied with Construction Noise Permit
condition, and percussive piling was carried out between 12:15pm and 1:00pm
on 12th September 2017. Follow-up Action: Contractor stated that the following
measures had been implemented to mitigate noise generation during piling
works: 1.
During pile driving, a movable noise barrier and a hammer noise shield
had been provided for each pile. 2.
Sound proof canvas had been installed on site boundary near Kai Ching
Estate to mitigate noise generated from construction works. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-31479 |
26/09/2017 |
ArchSD Contract No.: SS C503 |
Hsin Chong – Build King Joint Venture |
Complainant
quoted percussive piling staring at 8:15am causes serious noise problems to
nearby residents and she saw noise barriers just laying on ground without
mounting up during the hammer was driving. |
Complaint was received concerning noise generated
from construction site. The case was referred to the Contractor by EPD via
email on 15h September 2017. Investigation was took place during weekly
site inspection, the details of the complaint investigation are as below: Background: A complaint received on 26th
September 2017 by EPD was referred to the Contractor on 28th
September 2017 regarding noise generated from construction site. Investigation Result: According to the contractor’s representative
response during weekly site inspection, contractor advised that they had
complied with Construction Noise Permit condition. Follow-up Action: During weekly site inspection Environmental
team had identified the following measures implemented by the contractor: 1.
Sound proof canvas had been installed around the site boundary to
mitigate noise generate from piling work. 2.
Contractor had reminded sub-contractor to strictly complied with
Construction Noise Permit condition. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
|
|||||||
17-33986 |
19/10/2017 |
Wheelock Properties Contract No: NKIL6541 |
Hip Hing Construction Company Limited |
Complainant
said that the accumulation of water caused unpleasant smell. |
Complaint was received concerning odour
emitted from construction site, The case was referred to the Contractor by
EPD via email on 23rd October 2017. According to the ET’s weekly site
inspection, the details of the complaint investigation are as below: Background: A complaint received on 19th October
2017 by EPD was referred to the Contractor on 23rd October 2017
regarding odour emitted from construction site. Investigation Result: During weekly site inspection on 27th
October 2017, environmental team had the following observations: 1.
Accumulated water within site perimeter had been cleared. 2.
There was no obvious odour emitting source identified on site. 3.
General refuse had been cleared regularly. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-34438 |
23/10/2017 |
HyD Contract No.: HY/2014/18 |
Buildking-Richwell Joint Venture |
Complainant
emphasized that dust emission was observed when vehicles running on the dry
surfaces outside Dakota Drive and Olympic Avenue. He/she hoped that water
spraying activities should be apply to all surfaces if there were vehicles
running on it. Complainant
also said vehicles were not clean enough before leaving the construction
site. |
Complaint was received concerning dust
emission outside Dakota Drive and Olympic Avenue. The case was referred to
the Contractor by EPD via email on 30th October 2017. According to the ET’s weekly site
inspection, the details of the complaint investigation were as below: Background: A complaint received on 23rd
October 2017 by EPD was referred to the Contractor on 30th October
2017 regarding dust emission outside Dakota Drive and Olympic Avenue. Follow-up Action: During weekly site inspection conducted by
environmental team the following mitigation measures had been observed: 1.
Sprinkler head had been installed to minimize dust emission from
unpaved road. 2.
Vehicles had been Wheel-washed before leaving site. 3.
Contractor had arranged workers to water haul road and unpaved road
constantly. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
CEDD Contract No.: KL/2015/02 |
Peako-Wo Hing Joint Venture |
Complaint was received concerning dust emission
outside Dakota Drive and Olympic Avenue. The case was referred to the
Contract by EPD via email on 30th October 2017. According to the Contractor’s ET’s response
to EPD, the details of the complaint investigation are as below: Background: A complaint received on 23rd
October 2017 by EPD was referred to the contractor on 30th October
2017 regarding dust emission outside Dakota Drive and Olympic Avenue. Mitigation Measures According to Contractor’s response to EPD,
the following mitigation measures had been implemented after receiving
complaint: 1.
Water spraying had been provided along haul road and unpaved road for
dust suppression. 2.
Stockpile of dusty materials had been covered by impervious sheet. 3.
Designated wheel washing area had been provided. 4.
Breaking works were provided with water spraying. 5.
Contractor would hold meeting with other haul road users to raise
environmental awareness in particular the vehicles washing before leaving the
site. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
||||||||||
MTR Contract No. SCL 1109 |
Samsung-Hsin Chong Joint Venture |
Complaint was received concerning dust
emission outside Dakota Drive and Olympic Avenue. The case was referred to the
Contract by EPD via email on 30th October 2017. According to the Contractor’s monthly
EM&A report, the details of the complaint investigation are as below: Background: A complaint received on 23rd
October 2017 by EPD was referred to the contractor on 30th October
2017 regarding dust emission outside Dakota Drive and Olympic Avenue. Investigation: According to Contractor’s monthly EM&A
report, the findings and following actions were listed as follow: 1.
Regular water spraying and wheel washing activities had been arranged
to minimize dust generation in site area and along Dakota Drive and Olympic
Avenue. 2.
The impact dust data recorded adjacent to To Kwa Wan Station works
area on 20th and 26th October 2017 had been reviewed
and no action/ limit level was triggered. 3.
During Contractor’s weekly site inspection on 23rd October
2017, no adverse comment or observation about dust emission along Dakota
Drive and Olympic Avenue was recorded from Contractor’s inspection team. No further comment on the investigation results
above was received from EPD. The complaint case was found to be project
related. |
Closed |
||||||||||
17-35463 |
01/11/2017 |
ArchSD Contract No.: SS C503 |
Hsin Chong-Build King Joint Venture |
Complainant
(located at Choi Hung Estate) quoted excessive percussive piling noise was
heard from contractor’s site. |
Complaint was received concerning excessive
piling noise generated from construction site. The case was referred to the
Contractor by EPD via email on 23rd November 2017. According to the Environmental Team weekly
site inspection, the details of the complaint investigation are as below: Background: A complaint received on 1st November
2017 by EPD was referred to the contractor on 23rd November 2017
regarding noise generated from construction site. Investigation: During Environmental Team weekly site
inspection, the following measures had been identified: 1.
Sound proof canvas had been installed around the site boundary near
Choi Hung Estate to mitigate noise generate from piling work. 2.
Contractor had reminded sub-contractor to strictly comply with
Construction Noise Permit condition. 3.
Movable noise barrier had been installed on piling rig. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-36850 |
13/11/2017 |
ArchSD Contract No.: SS C503 |
Hsin Chong-Build King Joint Venture |
Complainant
(located at Kai Ching Estate) quoted excessive percussive piling noise was
heard from contractor’s site. |
Complaint was received concerning excessive
piling noise generated from construction site. The case was referred to the
Contractor by EPD via email on 23rd November 2017. According to the Environmental Team weekly
site inspection, the details of the complaint investigation are as below: Background: A complaint received on 13th
November 2017 by EPD was referred to the contractor on 23rd
November 2017 regarding noise generated from construction site. Investigation: During Environmental Team weekly site
inspection, the following measures had been identified: 3.
Sound proof canvas had been installed around the site boundary near Kai
Ching Estate to mitigate noise generate from piling work. 4.
Contractor had reminded sub-contractor to strictly comply with
Construction Noise Permit condition. 4.
Movable noise barrier had been installed on piling rig. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-36905 |
13/11/2017 |
ArchSD Contract No.: SD E516 |
Hop Lee Builders Co. Ltd. |
Complainant
quoted loud breaking noise was heard at 8:00am and caused serious impact to
her family and neighborhood. |
Complaint was received concerning breaking
noise heard at 8:00am. The case was referred to the Contractor by EPD via
email on 15th November 2017. According to the reply from ArchSD, the
details of the complaint investigation are as below: Background: A complaint received on 13th
November 2017 by EPD was referred to the Contractor on 15th
November 2017 regarding noise heard at 8:00am. Mitigation Measures: According to the reply from ArchSD, the
following mitigation measures had been implemented after receiving complaint: 1.
ArchSD had urged the contractor to install temporary noise barrier to
mitigate noise generated. 2.
Noise generating works has been rescheduling after 9:00am, in order to
reduce nuisance toward the neighbor. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-37003 |
|||||||||||||
17-37255 |
16/11/2017 |
ArchSD Contract: SS E517 |
Hanison Construction Company Limited |
Complainant
quoted dust emission was observed from the construction site and saw piling
works was operating to 7:05pm on 15/11/2017. |
Complaint was received concerning dust
emission observed from construction site. The case was referred to the
Contractor by EPD via email on 23rd November 2017. According to the reply from contractor via
email, the details of the complaint investigation are as below: Background: A complaint received on 16th
November 2017 by EPD was referred to the Contractor on 23rd
November 2017 regarding dust emission from construction site. Investigation Result: According to the Contractor’s reply,
percussive piling on 15th November 2017 was stopped before 6:45pm
and compiled with Construction Noise Permit conditions. Contractor stated
that the following measures had been implemented to mitigate dust emission: 1.
Excavation materials had been covered by impervious sheeting. 2.
Automatic water spraying system was installed. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
17-39960 |
11/12/2017 |
Poly Property Contract: NKIL 6527 |
Paul Y. Builders Limited |
Complainant
quoted that workers were found and hammering noise was heard from Contractor’s
construction site within 9:00am and 15:00pm of recent Sundays. |

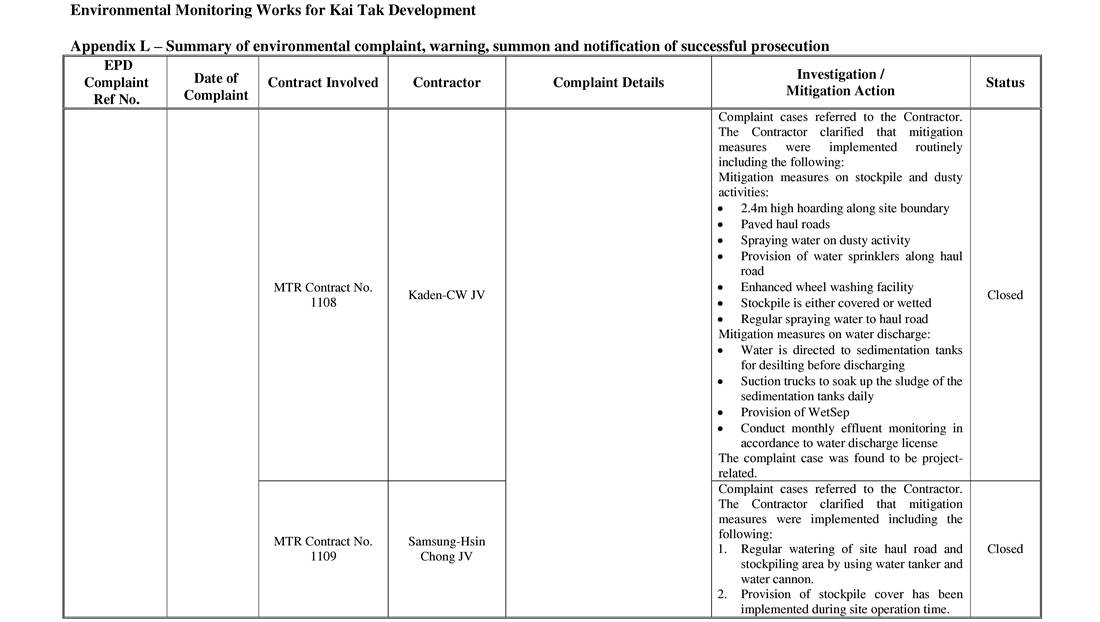

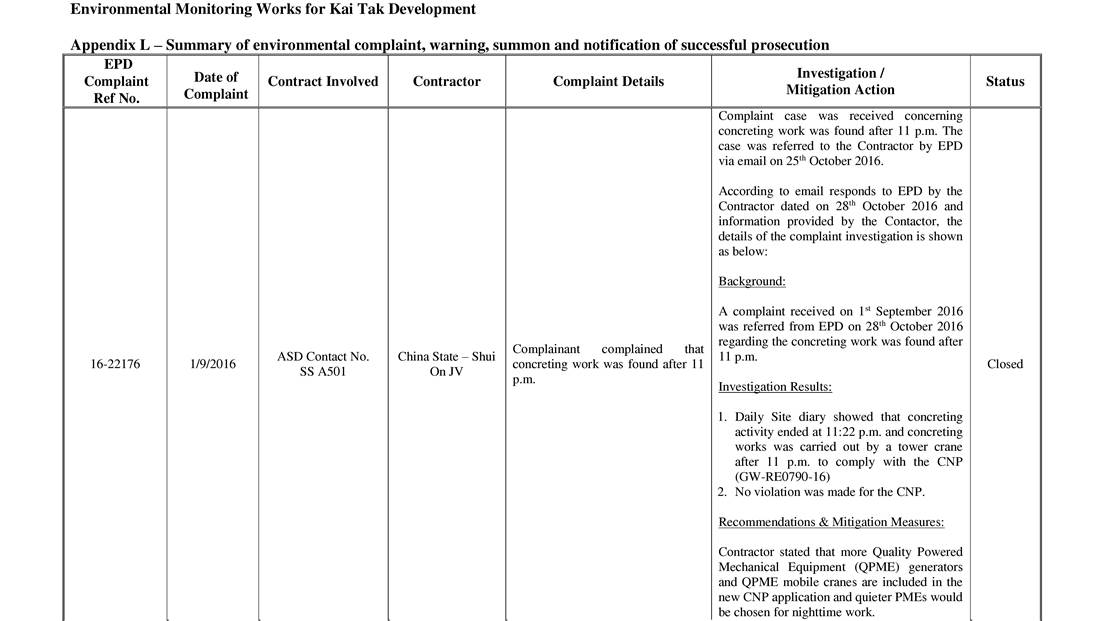

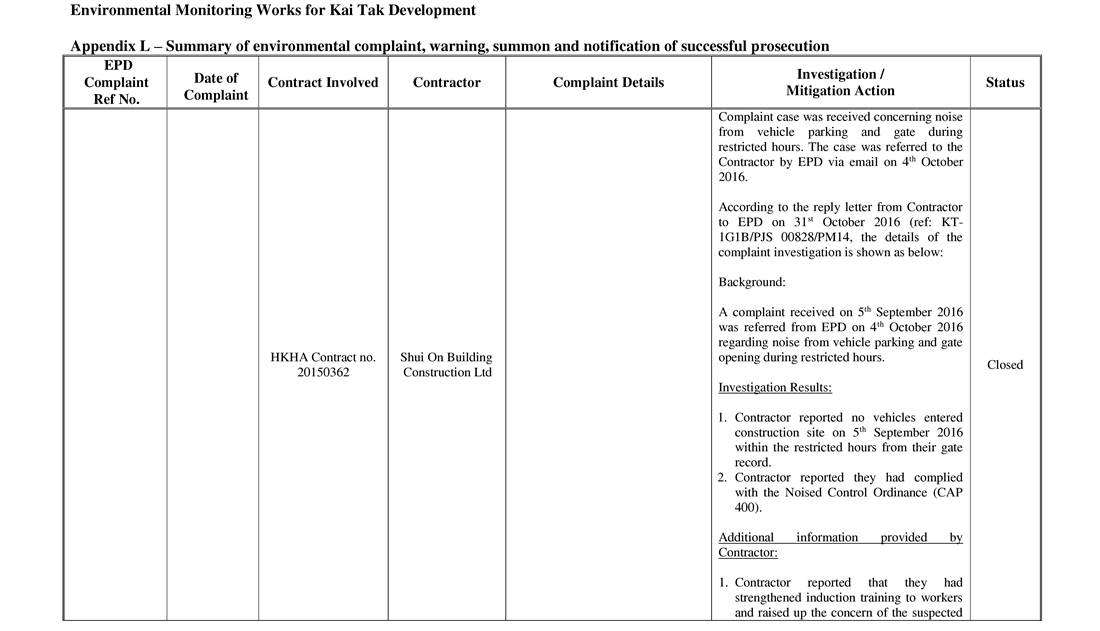

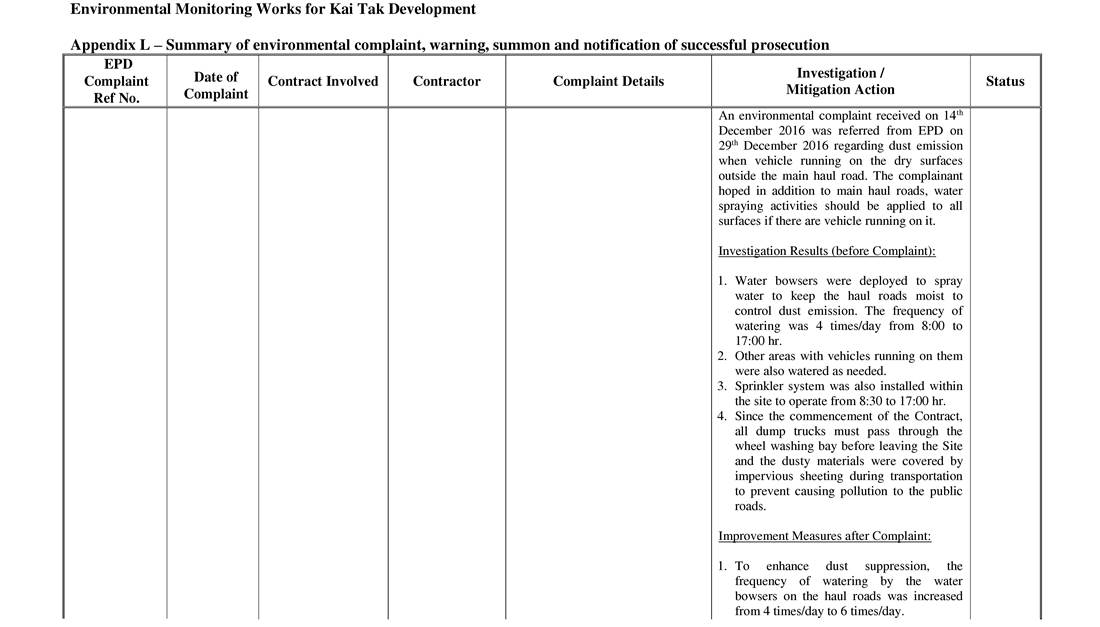

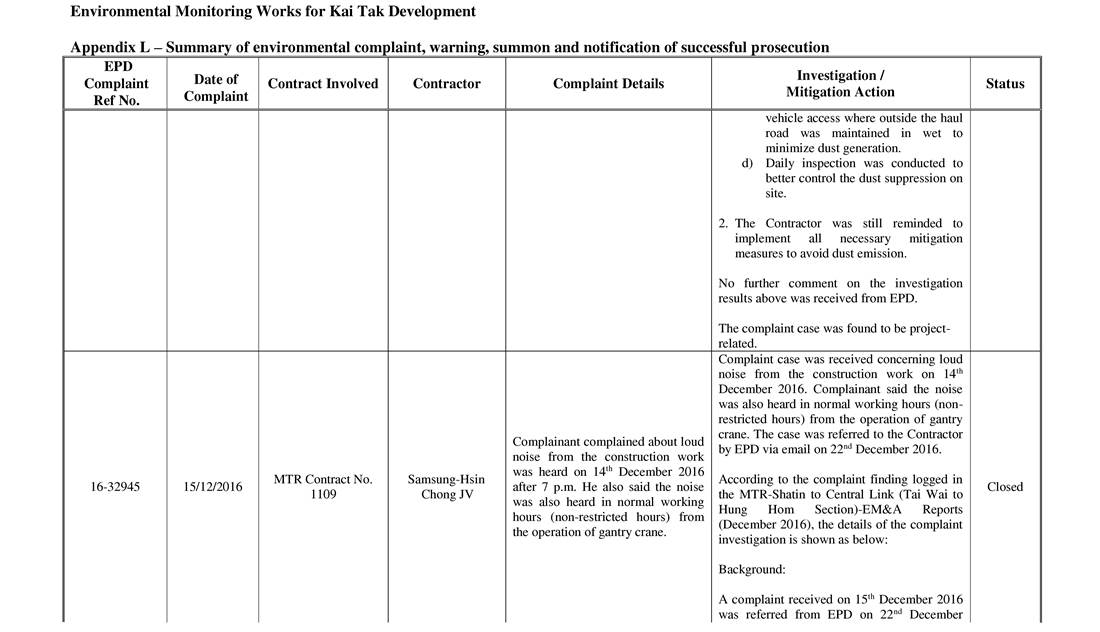

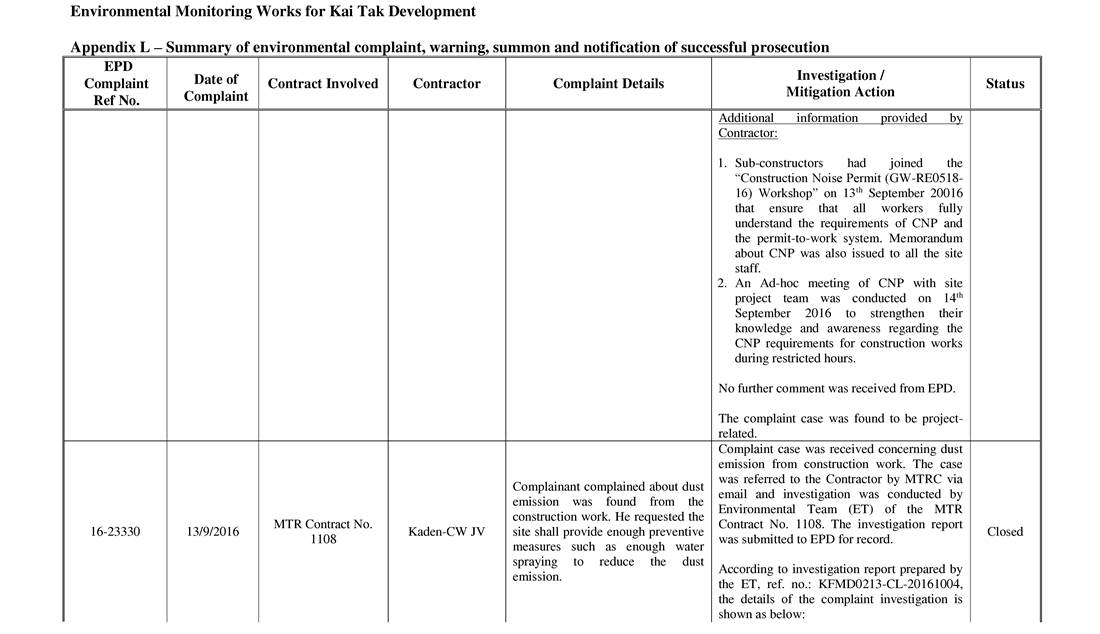

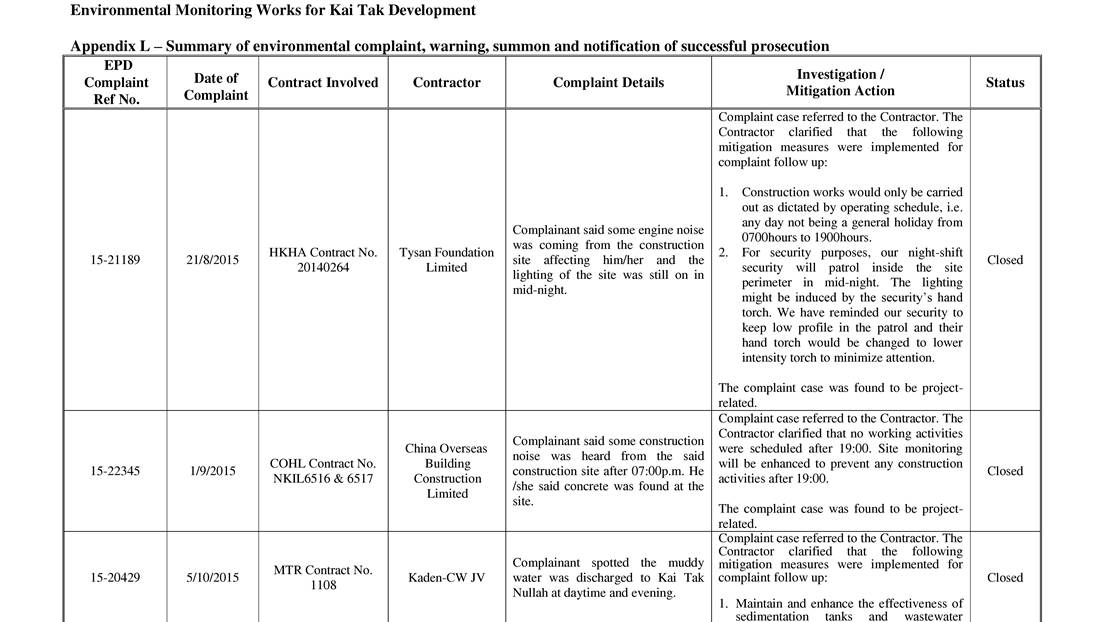

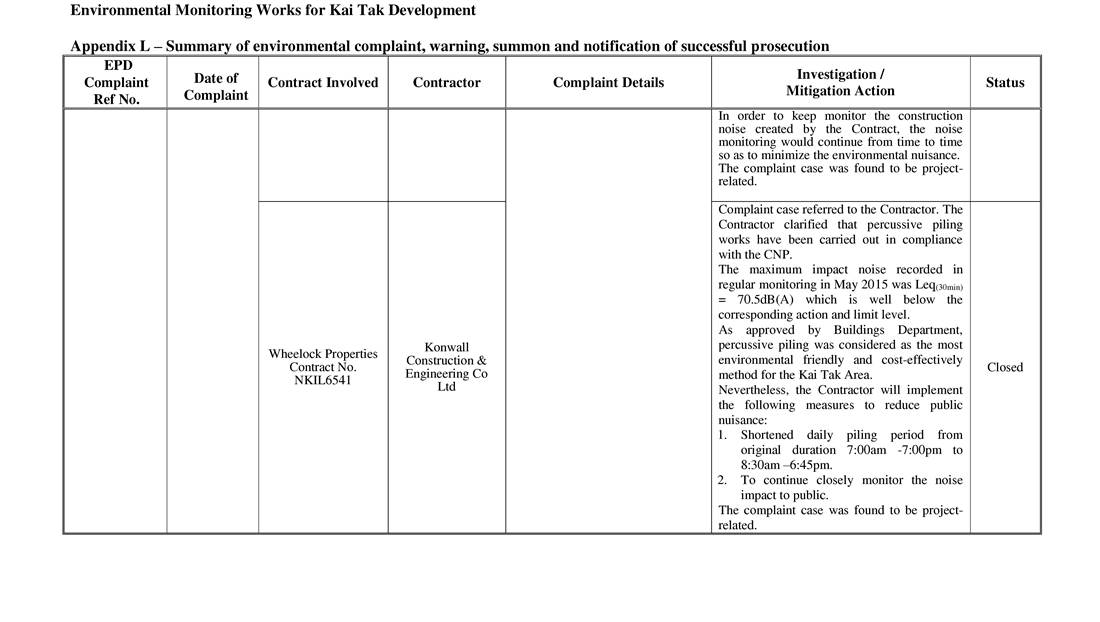

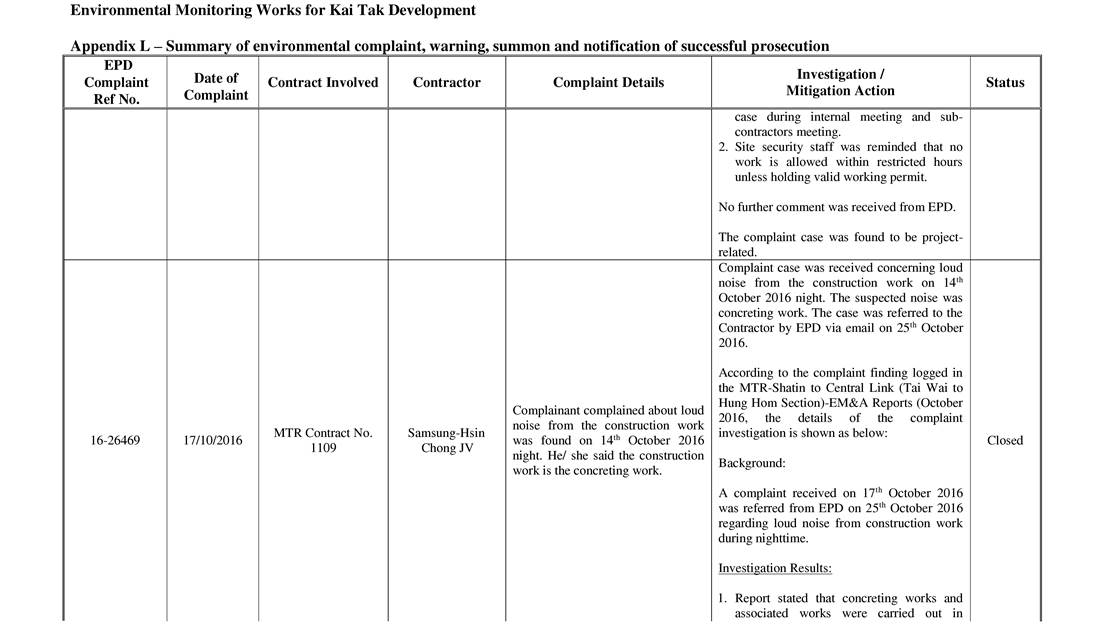

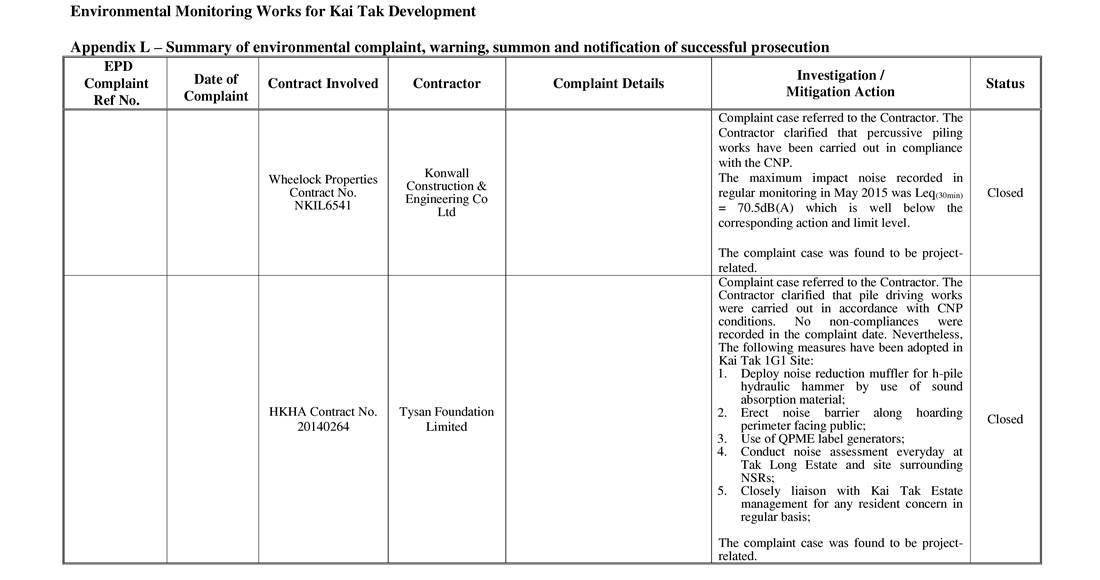

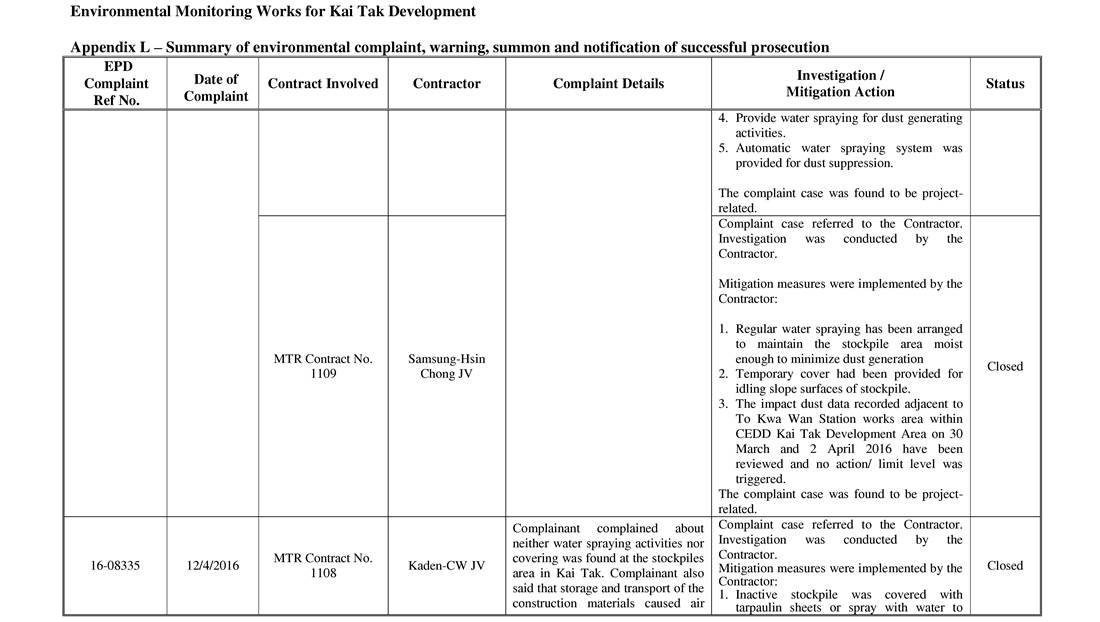

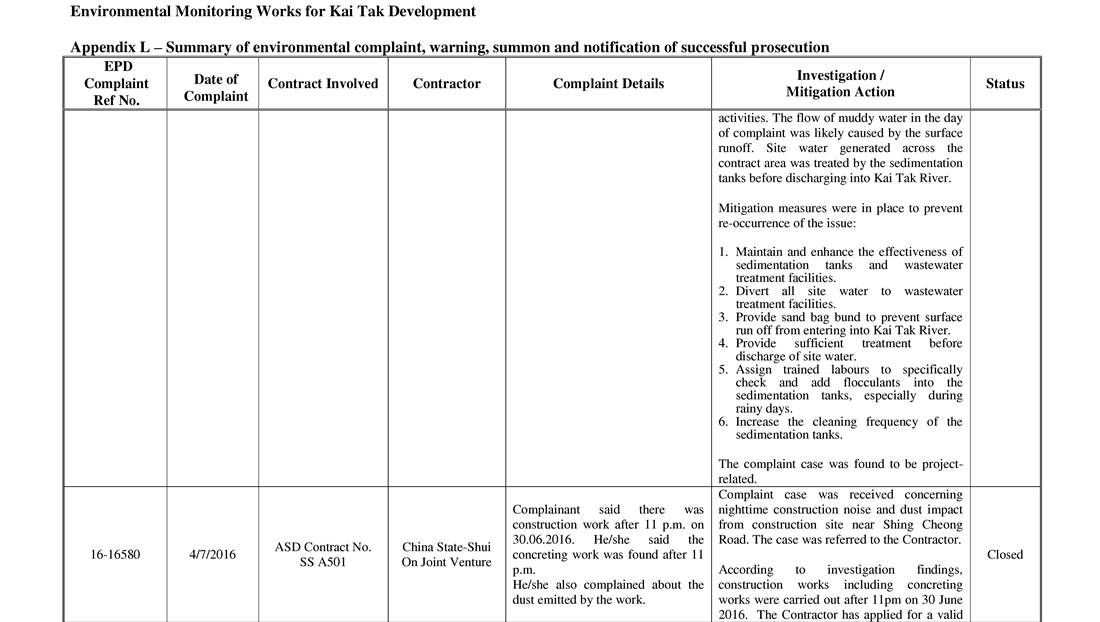

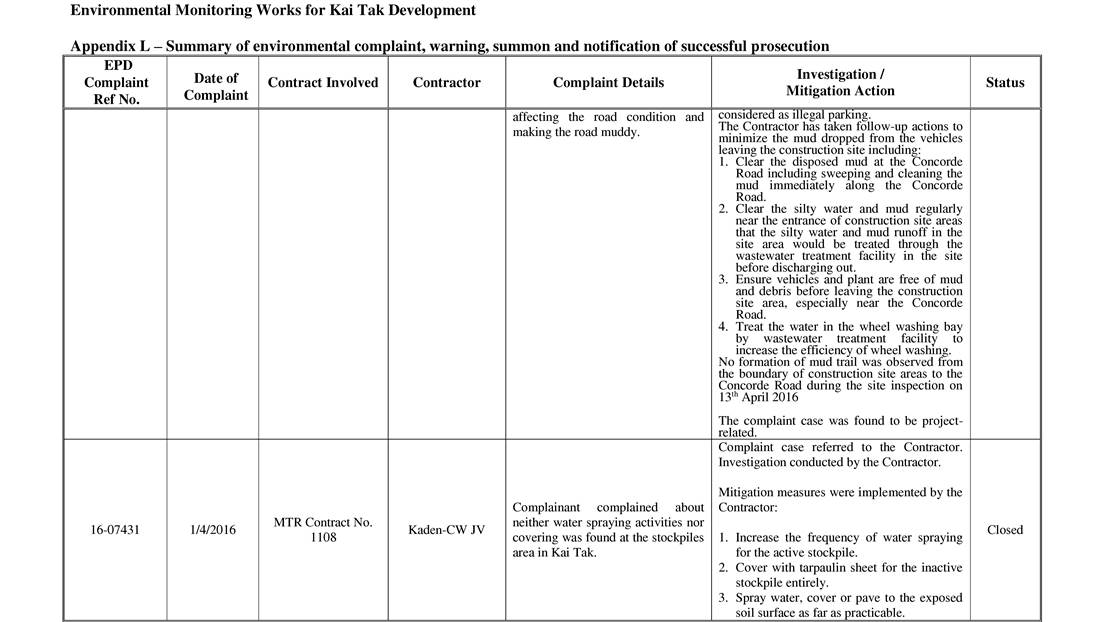

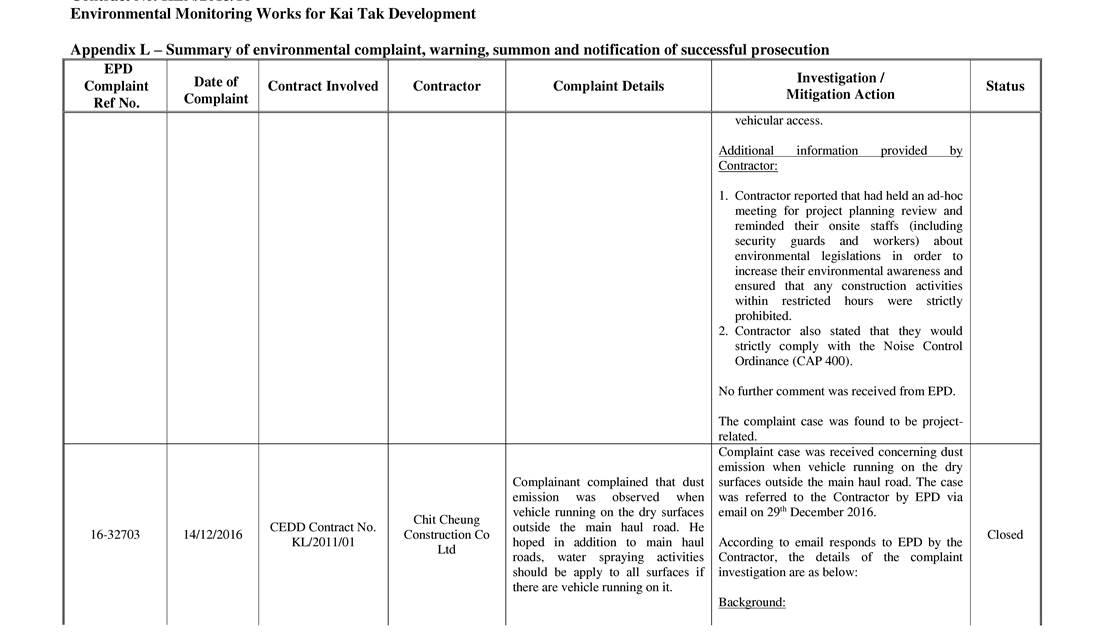

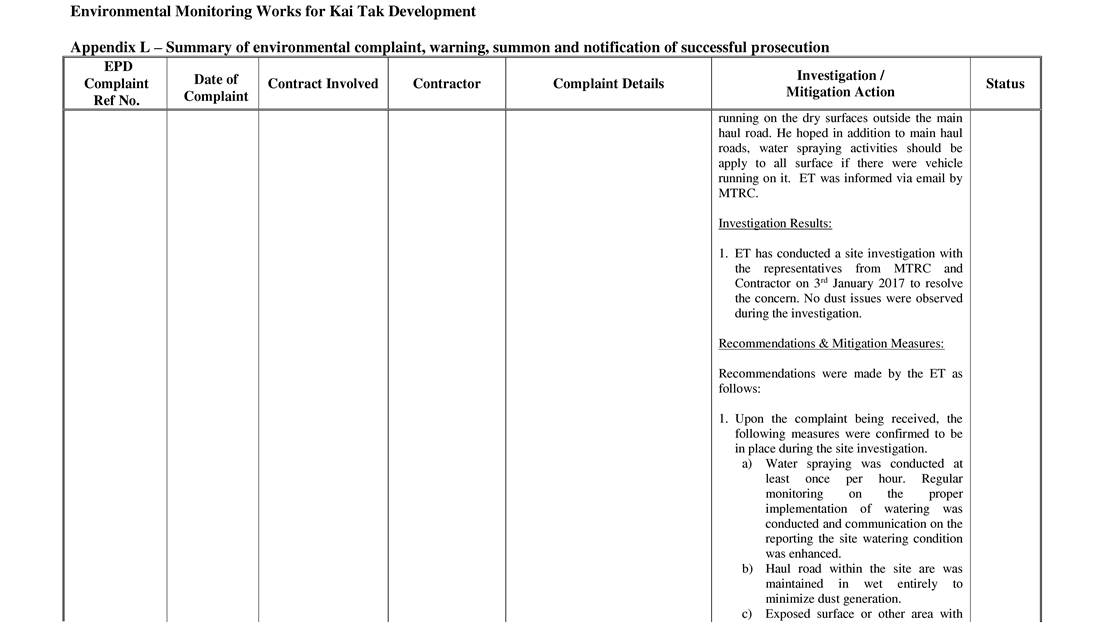

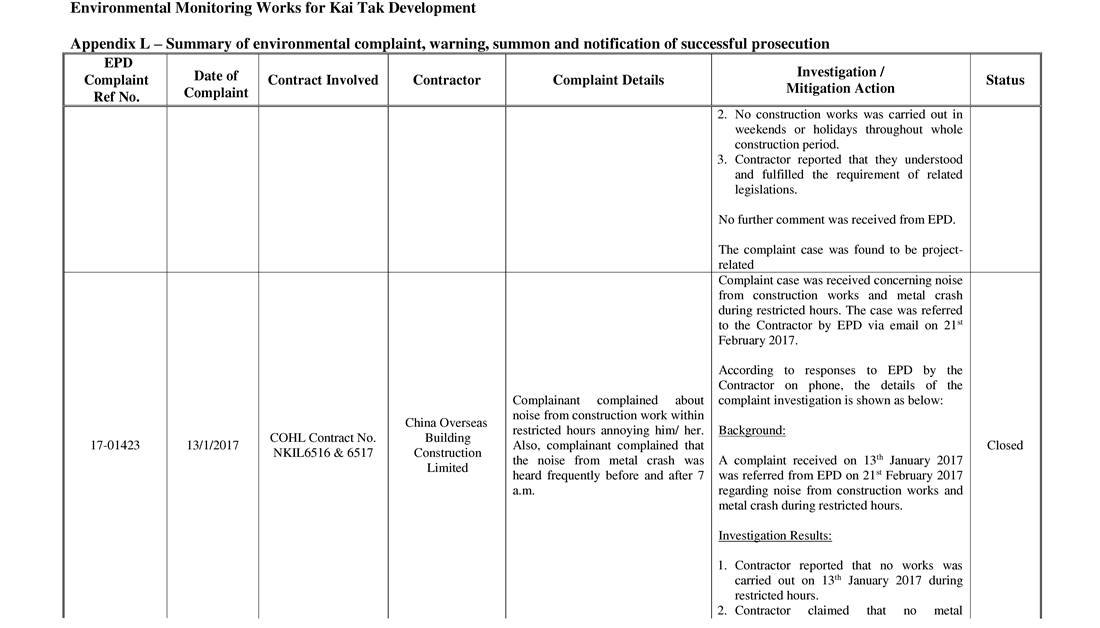

Complaint was received concerning noise
heard from construction site. The case was referred to the Contractor by EPD
via email on 20th December 2017. According to the reply from contractor via monthly
performance survey, the details of the complaint investigation are as below: Background: A complaint received on 11h December
2017 by EPD was referred to the Contractor on 20th December 2017
regarding noise from construction site. Investigation Result: According to Contractor’s reply via monthly
performance survey, after Contractor’s investigation. It was found out site
cleaning works were carried out on Sundays (3 and 10 December 2017). After
receiving the complaint Contractor had implemented the following measures to
reduce noise from construction site: 1.
Noise reduction sheets were installed on temporary rubbish chute and
site hoarding. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||

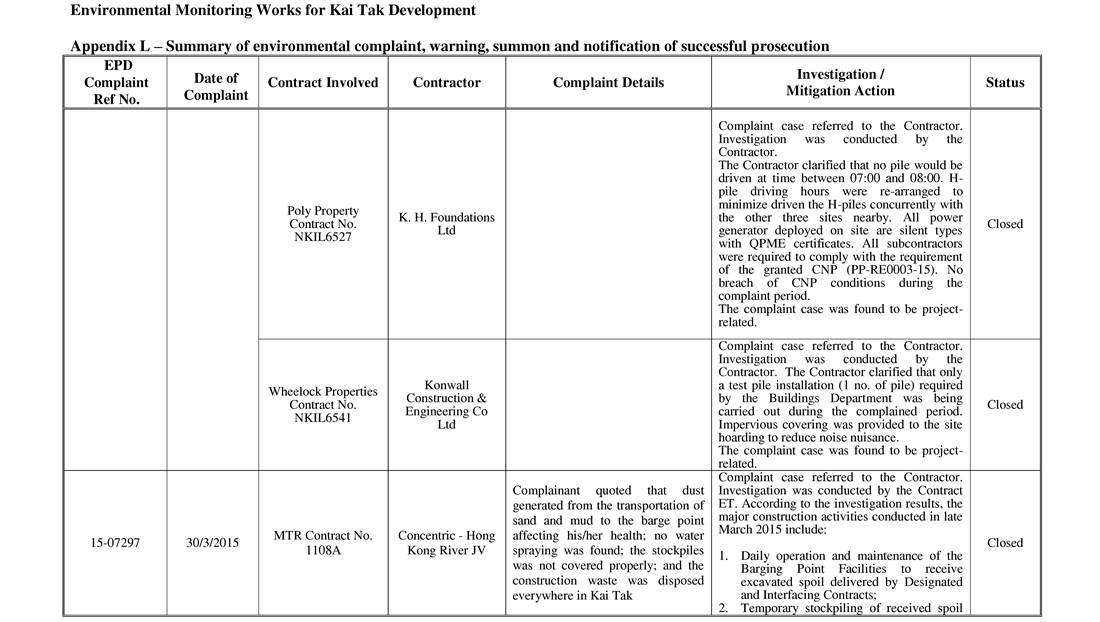

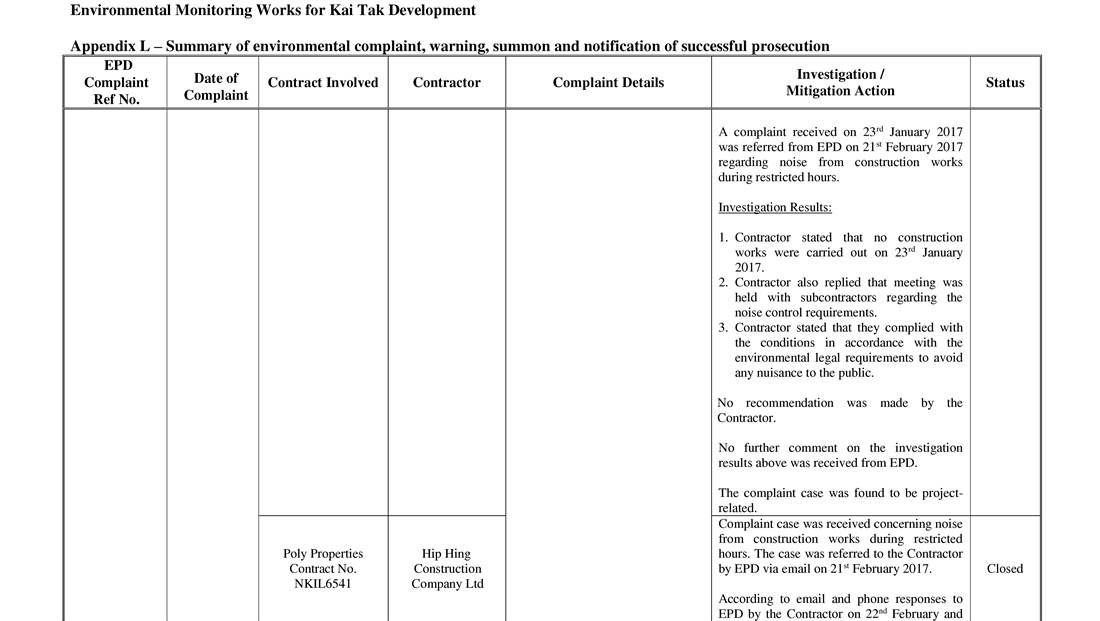

Wheelock Properties Contract: NKIL 6541 |
Hip Hing Construction Company Limited |

Complaint was received concerning noise
heard from construction site. The case was referred to the Contractor by EPD
via email on 20th December 2017. According to the reply from contractor via
monthly performance survey, the details of the complaint investigation are as
below: Background: A complaint received on 11h
December 2017 by EPD was referred to the Contractor on 20th
December 2017 regarding noise from construction site. Investigation Result: During weekly site inspection on ,
Environmental Team had the following findings: 1.
Acoustic enclosure had be installed for generators near resident to
reduce noise production. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
||||||||||
18-05351 |
26/02/2018 |
ArchSD Contract: SS C503 |
Hsin Chong – Build King Joint Venture |
Complainant
stated that piling noise was heard but no acoustic barriers were set up to
reduce the noise nuisance |
Complaint was received concerning piling
noise heard from construction site. The case was referred to the Contractor
by EPD via email on 6th March 2018. According to the weekly site inspection on
9th March 2018, the details of the complaint investigation are as below: Background: A complaint received on 26th February 2018
by EPD was referred to the Contractor on 6th March 2018 regarding piling
noise from construction site. Investigation Result: During weekly site inspection on 9th March
2018, Environmental Team had the following findings: According to the Contractor, piling machine
was on standby mode for PDA tests and loading tests during 23rd February to
9th March 2018. The weekly site inspection on 23rd
February and 9th March 2018 conducted by the Environmental Team also proved
that the piling machine was on standby mode. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
Century Base Development Limited Project Contract
No.: NKIL 6567 |

New Concepts Foundation Ltd. |
Complaint was received concerning piling
noise heard from construction site. The case was referred to the Contractor
by EPD via email on 6th March 2018. According to the reply from contractor to
EPD via email, the details of the complaint investigation are as below: Background: A complaint received on 26th
February 2018 by EPD was referred to the Contractor on 6th March
2018 regarding piling noise from construction site. Investigation Result: Contractor stated that several adjacent
construction sites were carrying out percussive piling works at the same
time. Follow up Action: Contractor stated that they would provide
additional noise insulation material to pile driver. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
||||||||||
Century Basis Limited Project Contract No.: NKIL
6566 |
Kin Wing Foundations Ltd. |
Complaint was received concerning piling
noise heard from construction site. The case was referred to the Contractor
by EPD via email on 6th March 2018. According to the reply from contractor via
email, the details of the complaint investigation are as below: Background: A complaint received on 26th
February 2018 by EPD was referred to the Contractor on 6th March
2018 regarding piling noise from construction site. Investigation Result: Contractor stated that there were no works
carried out during the restricted hours at that period. Follow up Action: Contractor would provide noise barrier near
the machine to lower sound level. And only machinery listed on the CNP would
be used. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
||||||||||
HKCIM Project Contract No.: NKIL 6562 |
Tysan Foundation Geotechnical Ltd. |
Complaint was received concerning piling
noise heard from construction site. The case was referred to the Contractor
by EPD via email on 6th March 2018. According to the weekly site inspection on
9th March 2018, the details of the complaint investigation are as
below: Background: A complaint received on 26th
February 2018 by EPD was referred to the Contractor on 6th March
2018 regarding piling noise from construction site. Investigation Result: During weekly site inspection on 9th
March 2018, contract no. NKIL 6562 had been cleared. There were no personnel
or equipment were on site. By reviewing photo taken during weekly site
inspection on 23rd February 2018, there were no personnel or
equipment on site either. No further comment on the investigation results above was received
from EPD. The complaint case was found not to be project related. |
Closed |
||||||||||
HKCIM Project Contract No.: NKIL 6563 |
Complaint was received concerning piling
noise heard from construction site. The case was referred to the Contractor
by EPD via email on 6th March 2018. According to the weekly site inspection on
9th March 2018, the details of the complaint investigation are as below: Background: A complaint received on 26th February 2018
by EPD was referred to the Contractor on 6th March 2018 regarding piling
noise from construction site. Investigation Result: During weekly site inspection on 9th March
2018, there were no piling works undertaken in NKIL 6563. By reviewing photo
taken during site inspection on 23rd February 2018, there were no personnel
or equipment on site either. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||||||
HKCIM Project Contract No.: NKIL 6564 |
Complaint was received concerning piling
noise heard from construction site. The case was referred to the Contractor
by EPD via email on 6th March 2018. According to the weekly site inspection on
9th March 2018, the details of the complaint investigation are as below: Background: A complaint received on 26th February 2018
by EPD was referred to the Contractor on 6th March 2018 regarding piling
noise from construction site. Investigation Result: During weekly site inspection on 9th March
2018, there were no piling works undertaken in NKIL 6564. By reviewing photo
taken during site inspection on 23rd February 2018, there were no personnel
or equipment on site either. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||||||
HKCIM Project Contract No.: NKIL 6565 |
Complaint was received concerning piling noise
heard from construction site. The case was referred to the Contractor by EPD
via email on 6th March 2018. According to the weekly site inspection on
9th March 2018, the details of the complaint investigation are as
below: Background: A complaint received on 26th
February 2018 by EPD was referred to the Contractor on 6th March
2018 regarding piling noise from construction site. Investigation Result: During weekly site inspection on 9th
March 2018, contract no. NKIL 6565 had been cleared. And no personnel or equipment
were on site. By reviewing photo taken during weekly site inspection on 23rd
February 2018, there were no personnel or equipment on site either. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||||||
18-7414 |
19/03/2018 |
Leader Bright Limited Project Contract No.:
NKIL6557 |
Tysan Foundation Geotechnical Limited |
Annoying high
frequency machine noise was heard in the morning (7:00am~9:00am) from the
site and woke many people up at nearby estate. |
Complaint was received concerning noise
heard from construction site. The case was referred to the Contractor by EPD
via email on 9th April 2018. According to the Contractor’s reply to EPD
via email on 26th April 2018, the detail of the complaint
investigation is as below: Background: A complaint received on 19th
March 2018 by EPD was referred to the Contractor on 9th April 2018
regarding noise from construction site. Follow-up Action: According to the Contractor’s reply to EPD
the following measures were taken after receiving the complaint: 1.
Main Contractor had notified subcontractors Plant Department of their
substandard issue; 2.
Construction plants had been forbidden to enter site from 7:00pm to
7:00am or public holiday; 3.
A temporary parking area had been created until the site gates are
opened within the permitted working hours. No further comment on the investigation results above was received
from EPD. The complaint case was found to be project related. |
Closed |
|||||||
18-8184 |
28/03/2018 |
Construction activity
was spotted & noise was heard within restricted hour (7:00pm~12:00pm) |
Complaint was received concerning noise heard from construction site.
The case was referred to the Contractor by EPD via email on 9th
April 2018. According to the Contractor’s reply to EPD via email on 26th
April 2018, the detail of the complaint investigation is as below: Background: A complaint received on 28th March 2018 by EPD was referred
to the Contractor on 9th April 2018 regarding noise from construction
site. According to the Contractor’s reply to EPD the following measures were
taken after receiving the complaint: 1.
After receiving complaint, the Contractor had carried out checking to
the crane. 2.
Noise emission from the crane was checked following its maintenance,
noise emission was found below limited level of 75dB. No further comment on the investigation results above was received
from EPD. The complaint case was found to be project related. |
Closed |
|||||||||
18-8874 |
04/04/2018 |
Visible dust emission
was spotted inside the site. |
Complaint was received concerning dust
emission from construction site. The case was referred to the Contractor by
EPD via email on 9th April 2018. According to the Contractor’s reply to EPD
via email on 26th April 2018, the details of the complaint
investigation are as below: Background: A complaint received on 4th
April 2018 by EPD was referred to the Contractor on 9th April 2018
regarding dust emission from construction site. Follow-up Action: According to the Contractor’s reply to EPD
the following measures were taken after receiving the complaint: 1.
The Contractor had increased the sprinkling of water to the ground and
covering of all stockpiling of dusty materials to minimize dust emission. 2.
The Contractor pointed out that their dust suppression measure had included
the area between their 2 sites. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||||
18-09657 |
12/04/2018 |
Leader Bright Limited Project Contract No.:
NKIL6557 |
Tysan Foundation Geotechnical Limited |
Complainant said
construction work inside Contractor’s site was conducted at night and
mid-night, complainant said annoying sharp noise was heard during Contractor’s
construction work. |
Complaint was received concerning noise
heard from construction site. The case was referred to the Contractor by EPD
via email on 21st May 2018. According to the Contractor, the details of
the complaint investigation are as below: Background: A complaint received on 12th
April 2018 by EPD was referred to the Contractor on 21st May 2018
regarding noise heard from construction site. Follow-up Action: According to the Contractor, the following
measures were taken after receiving the complaint: 1.
After receiving complaint, the Contractor had carried out checking to
the crane. 2.
Noise emission from the crane was checked following its maintenance,
noise emission was found below limited level of 75dB. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
18-10944 |
23/04/2018 |
MTR project Contract No.: SCL 1109 |
Samsung – Hsin Chong Joint Venture |
Complainant quoted
loud noise was generated from several breakers operation started at
7:00am~8:00am and woke up the residents of Sky Tower every morning. |
Complaint was received concerning noise
generated from construction site. The case was referred to the Contractor by
EPD via email on 26th April 2018. According to the Contractor’s
investigation, the detail of the complaint investigation are as below: Background: A complaint received on 23rd
April 2018 by EPD was referred to the Contractor on 26th April 2018 regarding

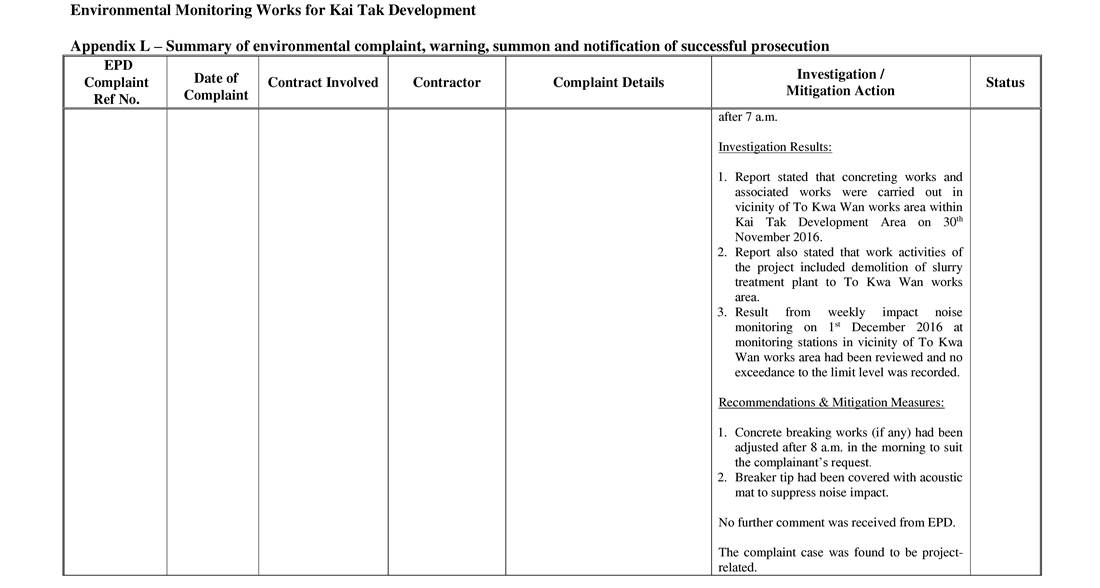

noised generated from construction site. Follow-up Action: According to the Contractor’s investigation
the following measures were taken after receiving the complaint: 1.
The noisy work had been postponed in the planning as far as possible. 2.
Breaker’s tip had been covered with noise barrier mat to suppress
noise impact. 3.
The results from weekly impact noise monitoring on 19th
April 2018 and 25th April 2018 at monitoring stations in vicinity
of Sung Wong Toi works area had been reviewed and no exceedance to the limit
level was recorded. 4.
During weekly inspection conducted by Contractor on 23rd April 2018,
no adverse comment or observation regarding construction noise in vicinity of
Sung Wong Toi works area recorded from the Contractor’s inspection team. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||

18-14107 |
24/05/2018 28/05/2018 |
KWH project Contract no.: NKIL 6526 |
Grand Tech Construction Co. Ltd. |
Complainant
(lives at啟德一號)
quoted high frequency vi-vi noise was generated from the construction site
intermittently at around 7:00pm ~ 01:00am from 22.05.2018 to 26.05.2018. |
Complaint was received concerning noise
heard from construction site. The case was referred to the Contractor by EPD
via email on 29th May 2018. According to the site inspection on 30th
May 2018 and 8th June 2018, the details of the complaint
investigation are as below: Background: A complaint received on 24th May
2018 and 28th May 2018 by EPD was referred to the Contractor on 29th
May 2018 regarding noise heard from construction site. Investigation Results: According to the site inspection on 30th
May 2018 and 8th June 2018, the following measures were taken
after receiving the complaint: 1.
After receiving complaint, Contractor had investigated the possible
cause for the high frequency noise, Contractor suspected the source might be from
fire alarm. 2.
Contractor had ordered sub-contractor responsible to fix the problem
of the fire alarm at the end of each day. 3.
Contractor had stayed behind to ensure no similar noise nuisance was reoccurred. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
|||||||
18-14685 |
28/05/2018 |
ArchSD project Contract no.: SS E517 |
Hanison Construction Company Limited |
Complainant (lives at
Kai Ching Estate) quoted dust emission was observed from the construction
site. Stockpile were found uncovered and dust was blowing into his home on
windy days. |
Complaint was received concerning dust
emission from construction site. The case was referred to the Contractor by
EPD via email on 31st May 2018. According to the Contractor’s reply to EPD
via email on 6th June 2018, the details of the complaint
investigation are as below: Background: A complaint received on 28th May
2018 by EPD was referred to the Contractor on 31st May 2018
regarding dust emission from construction site. Follow-up Action: According to the Contractor’s reply to EPD,
the following measures were taken after receiving the complaint: 1.
Contractor had covered stockpiles. 2.
Water spaying was applied during excavation. 3.
Water spraying facilities were deployed in dusty site areas. No further comment on the investigation
results above was received from EPD. The complaint case was found to be project
related. |
Closed |
